The overall pace of digging slowed down slightly today as we enter the closing stages of this year's summer dig on the site of Elsyng Palace in the woods of Forty Hall.

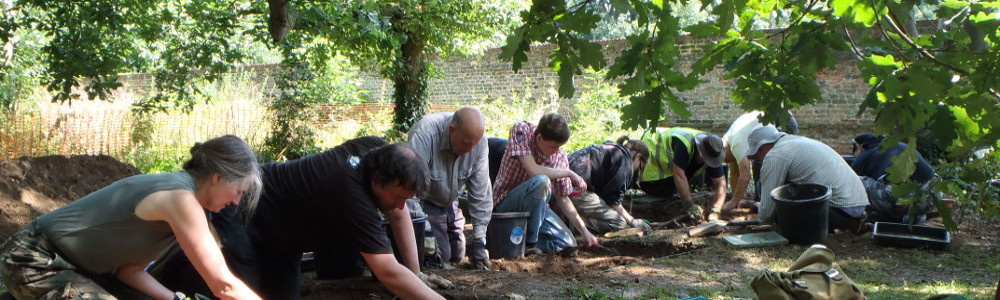

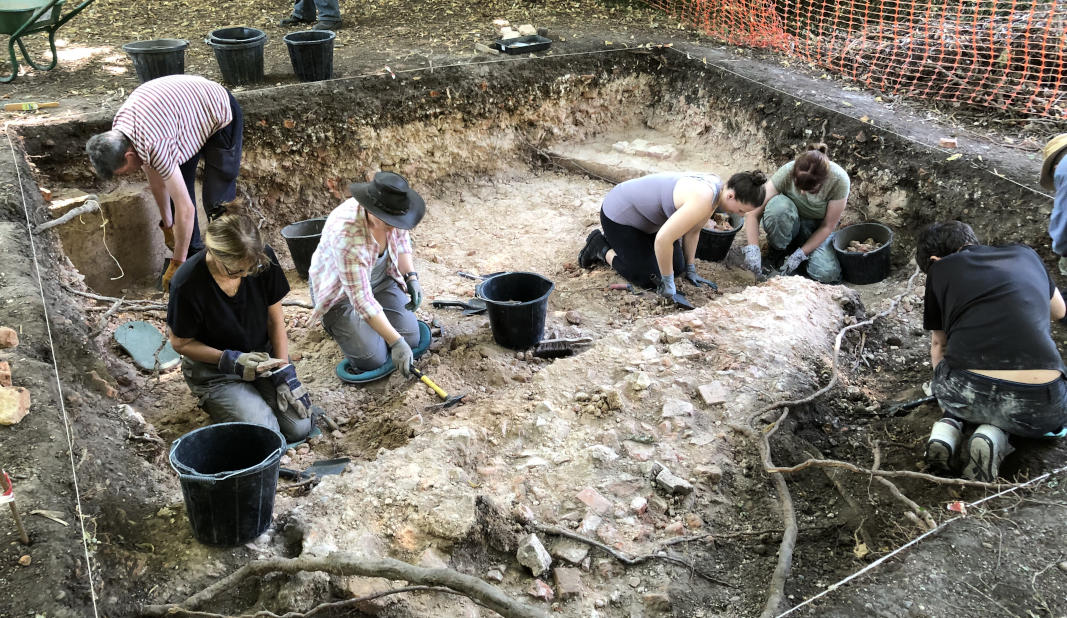

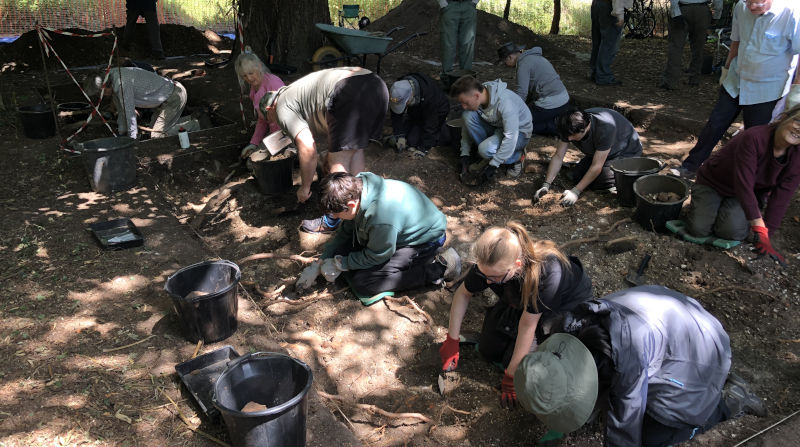

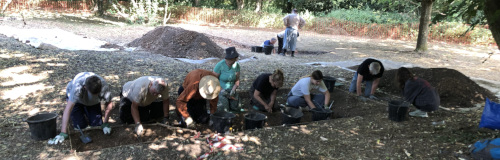

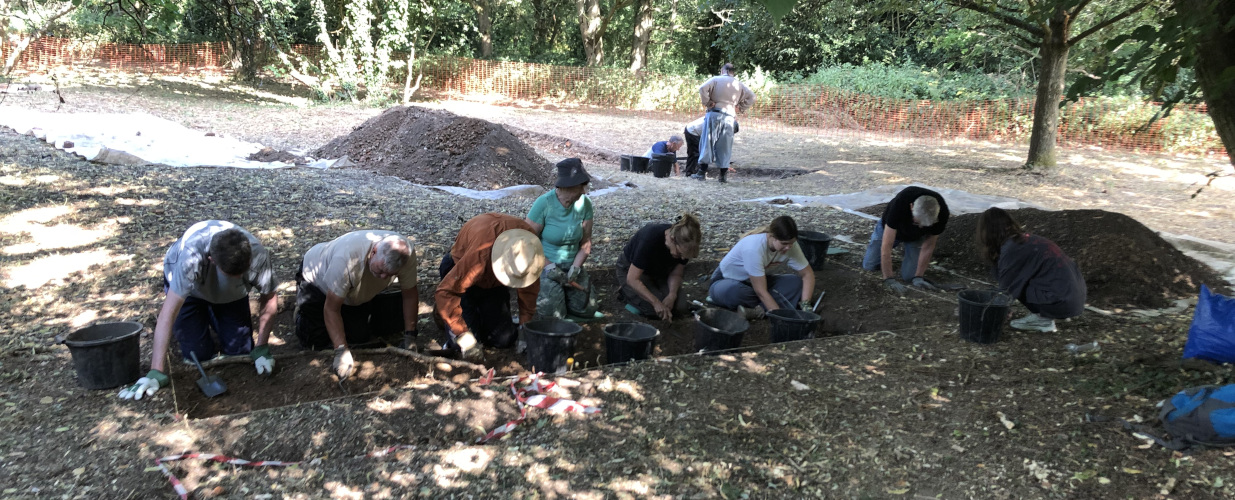

The Tudor archaeology has been concentrated mostly to a single trench this year but there's an awful lot going on in a very small area.

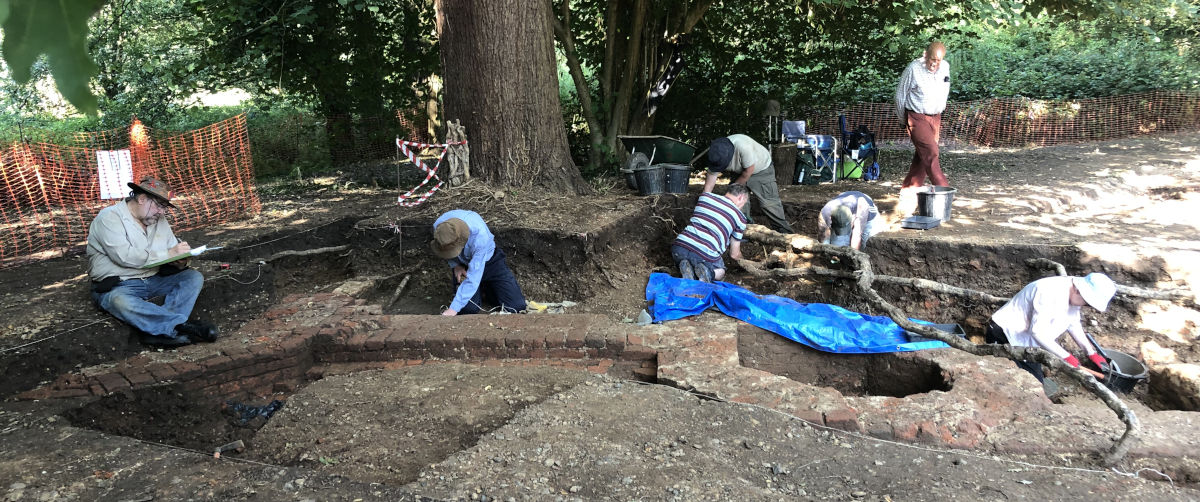

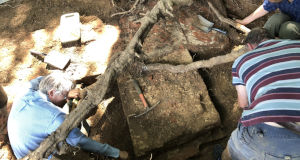

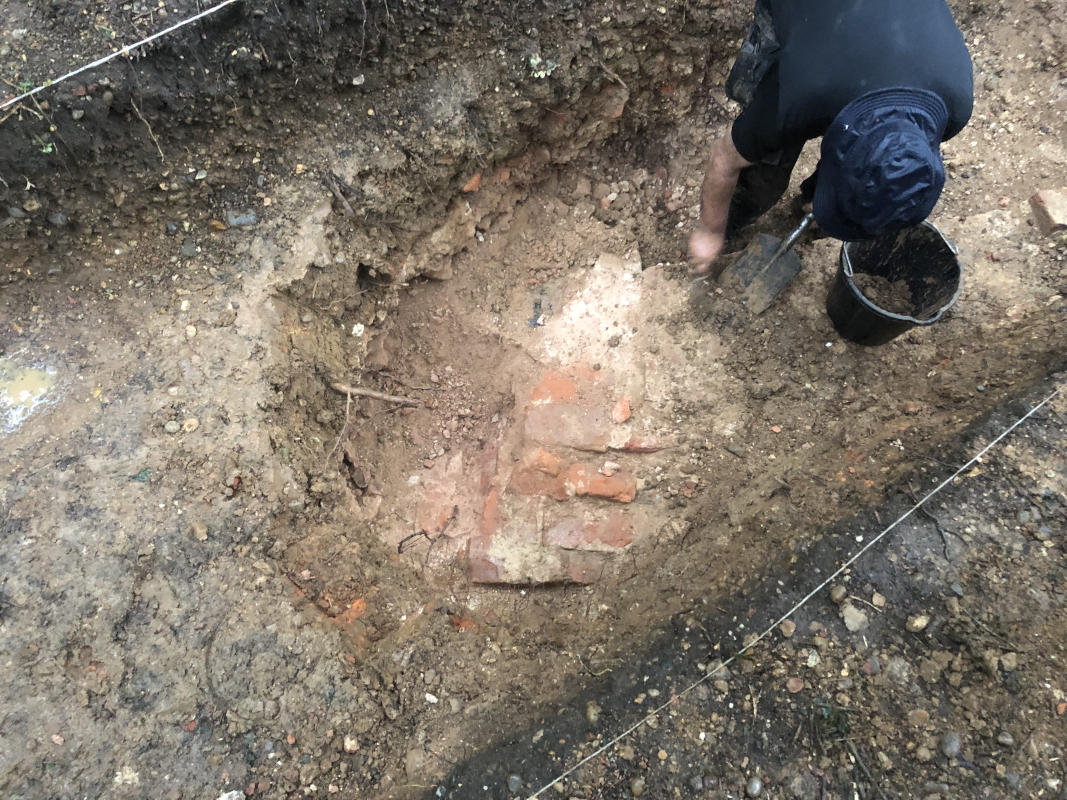

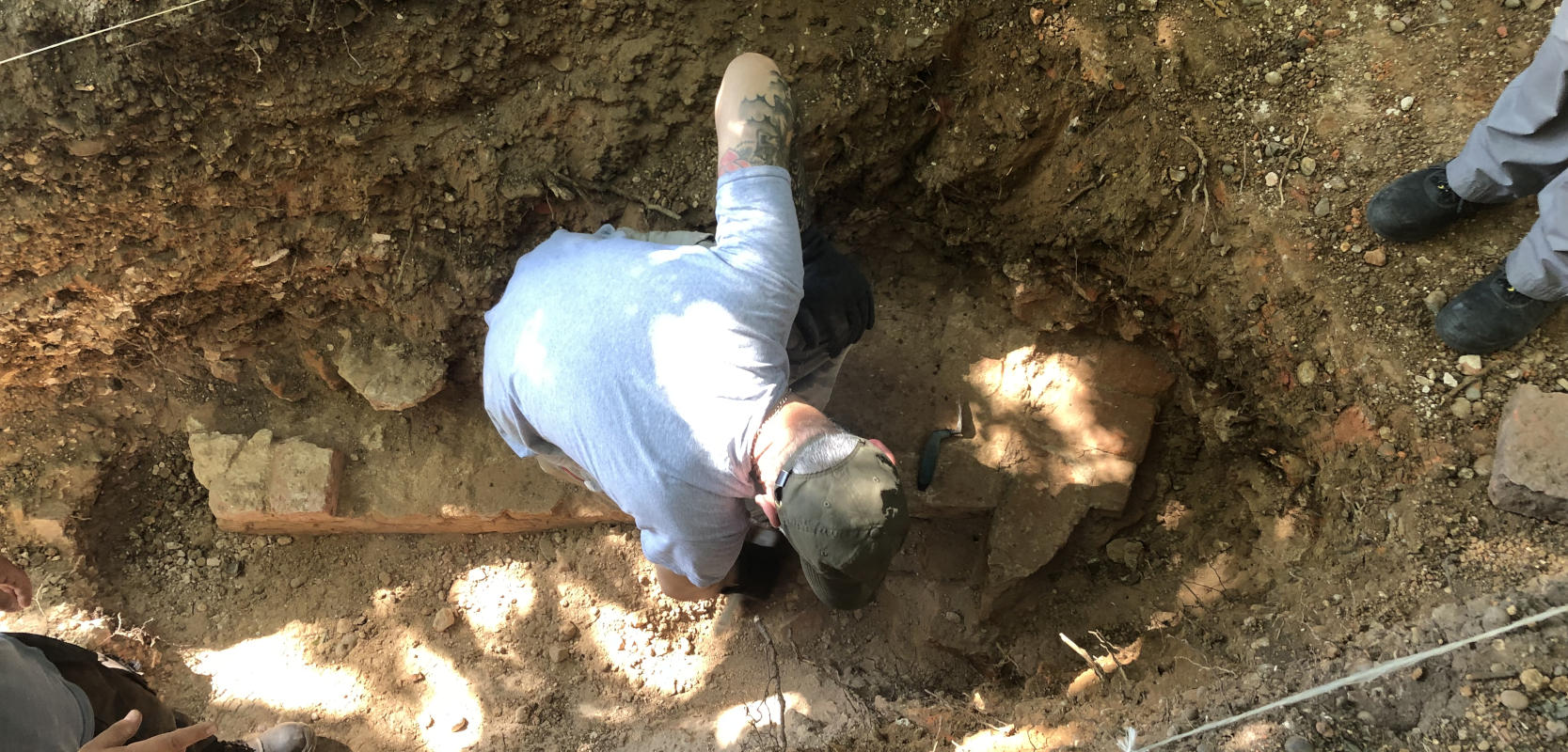

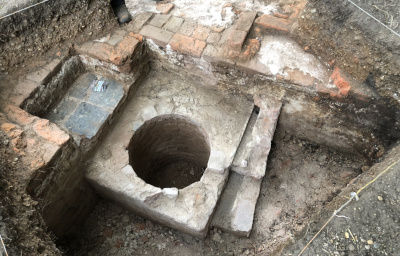

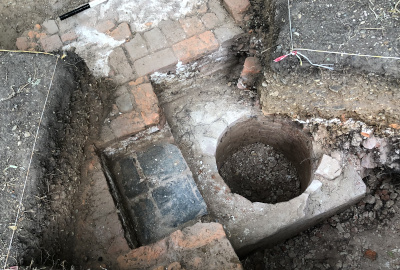

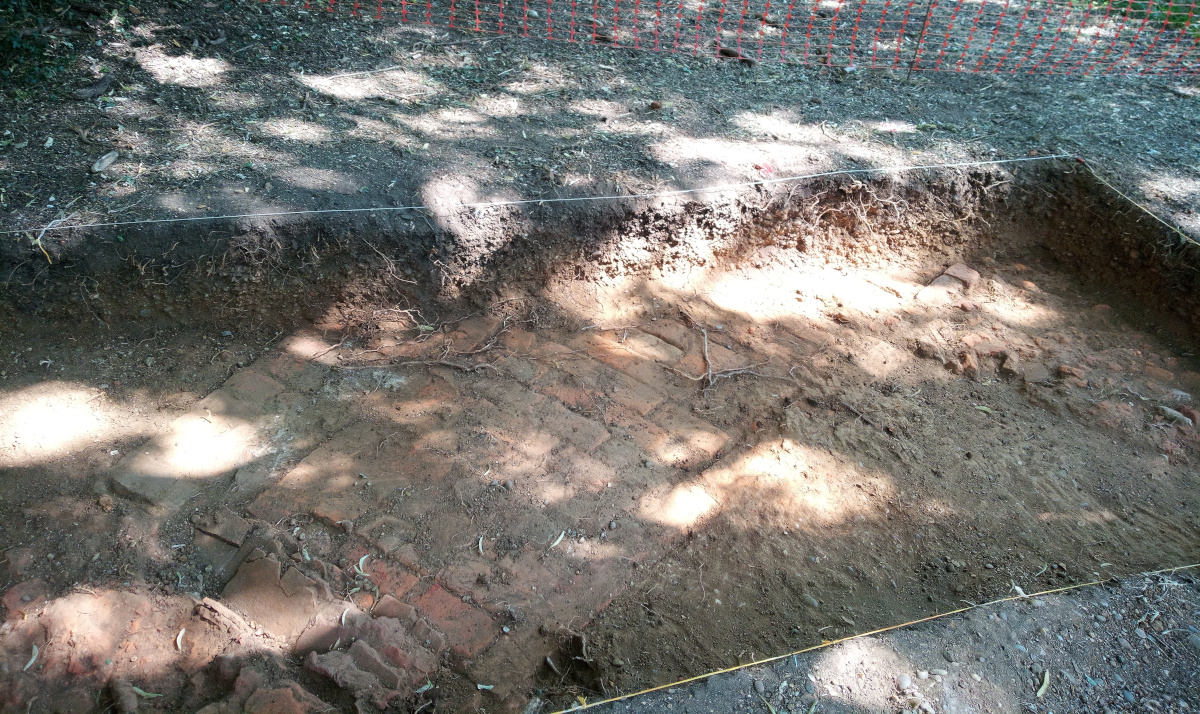

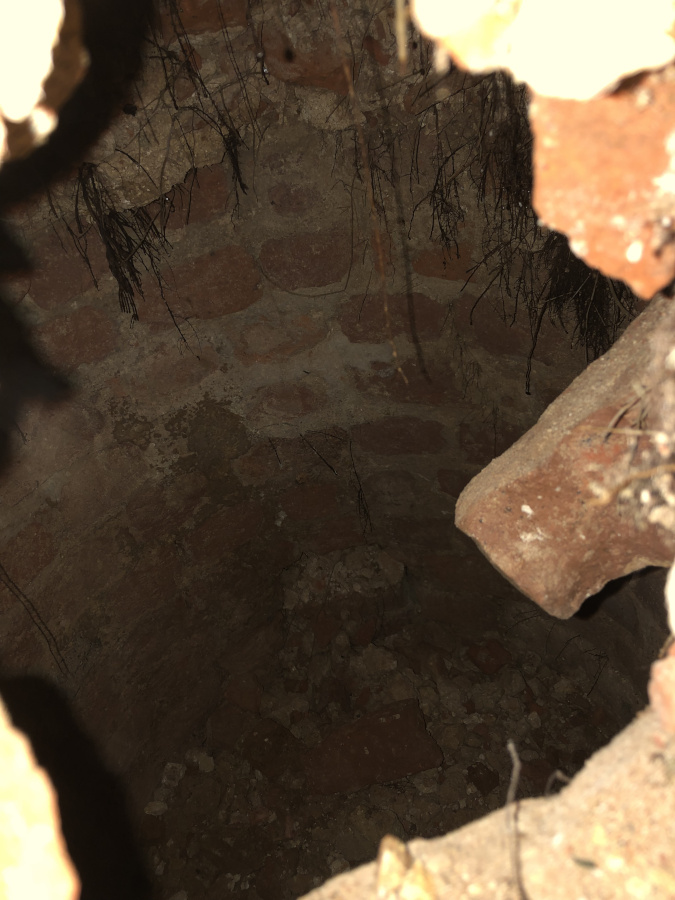

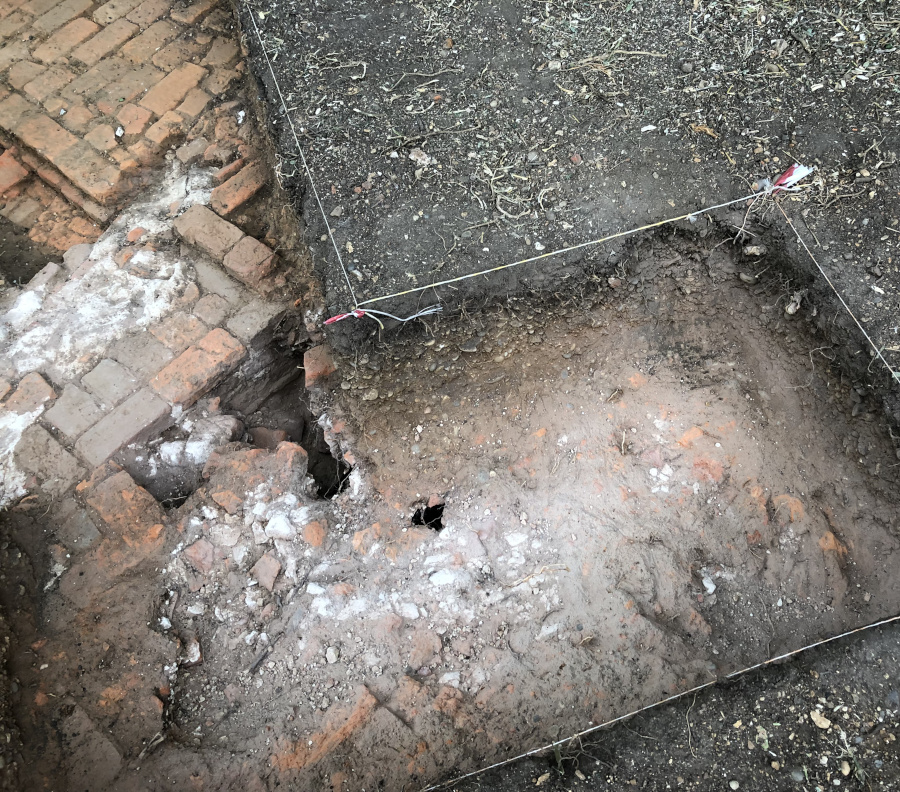

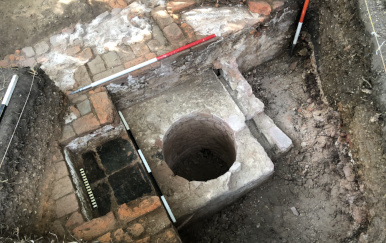

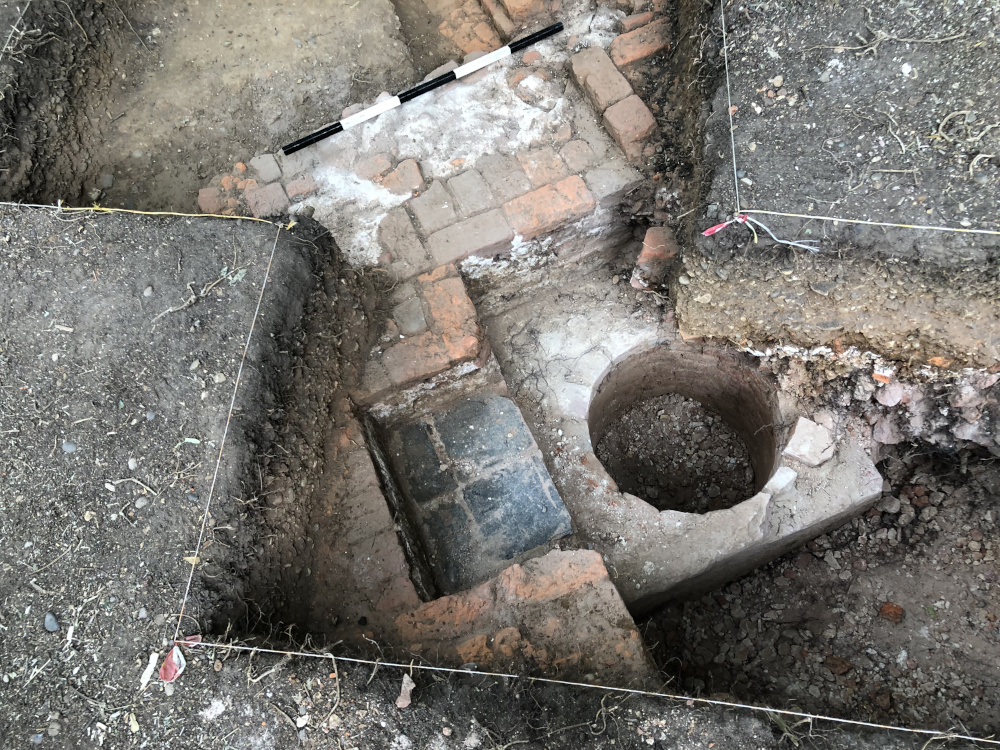

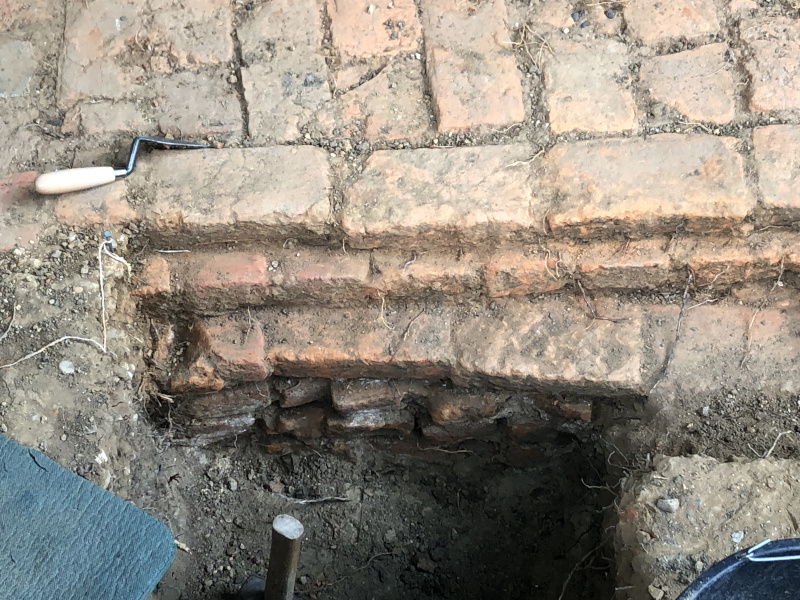

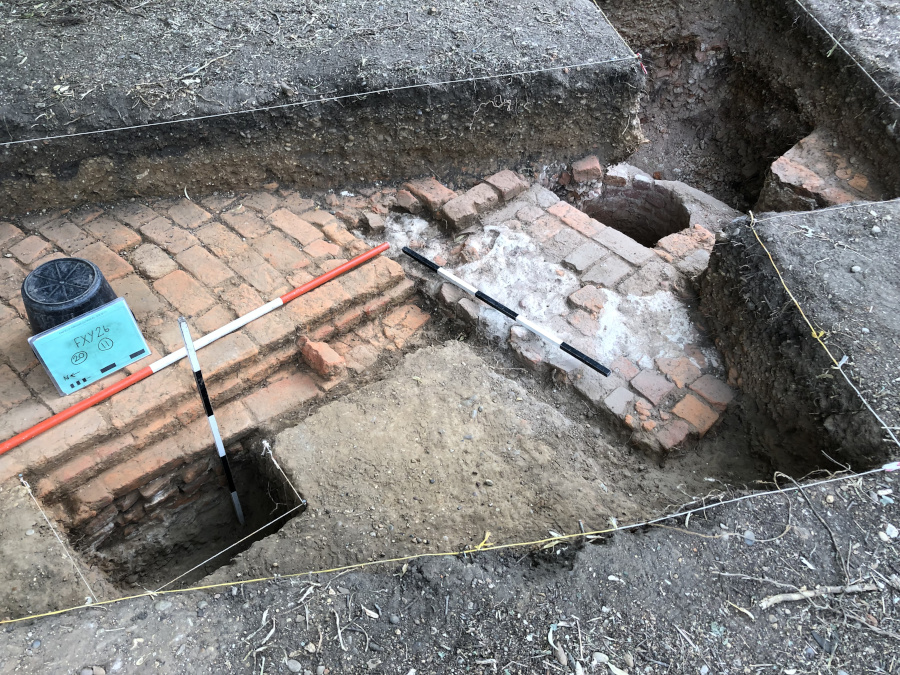

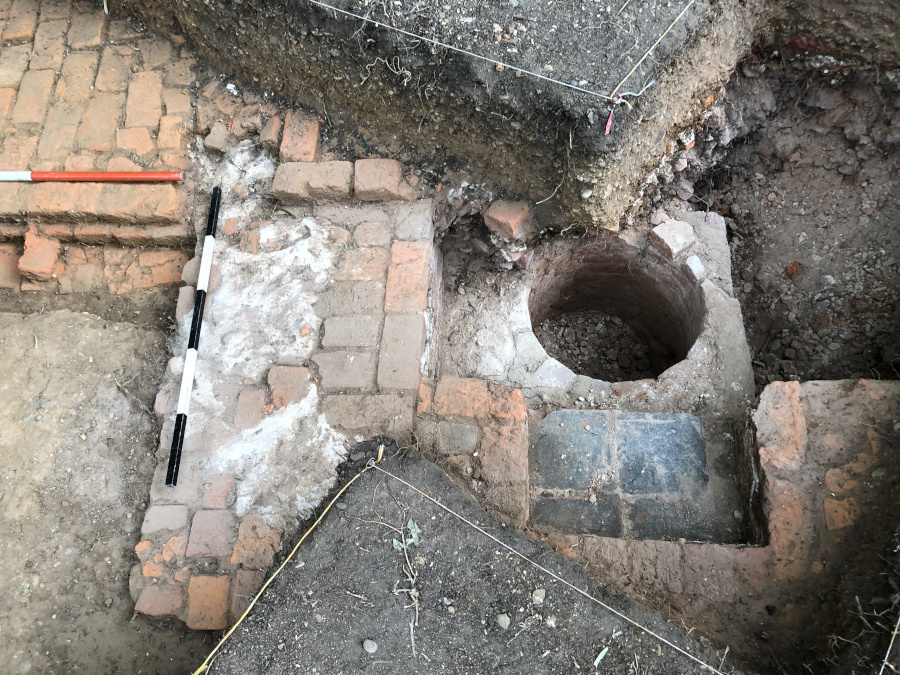

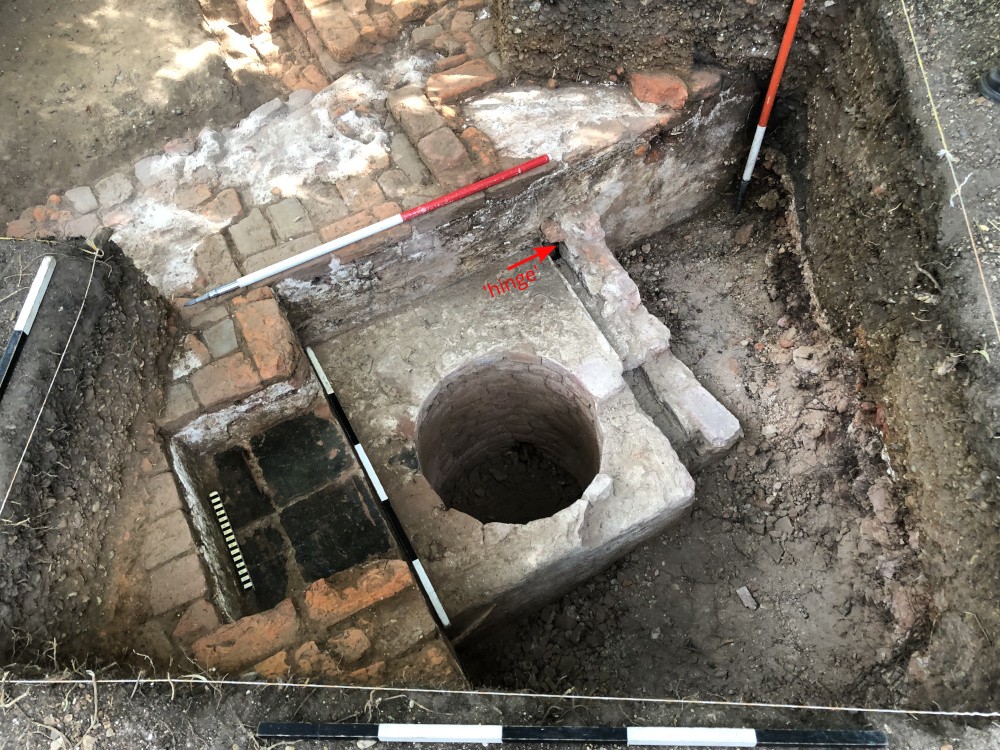

The most impressive feature this year has undoubtedly been the well chamber at the south end of Trench 2 and today it got even more impressive as we made one final small trench extension to fully uncover the circular chamber.

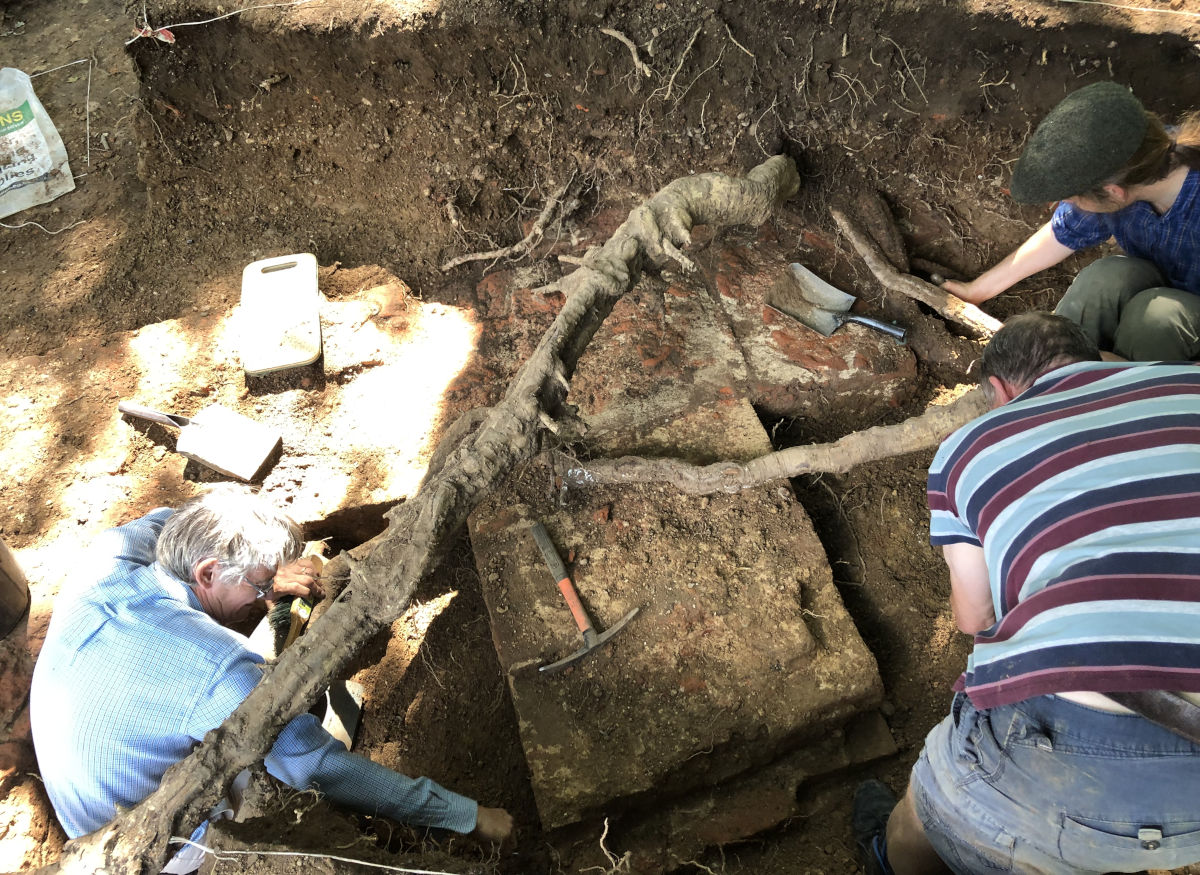

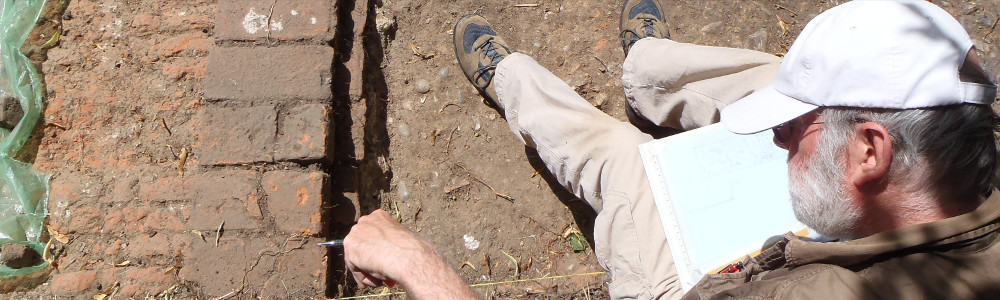

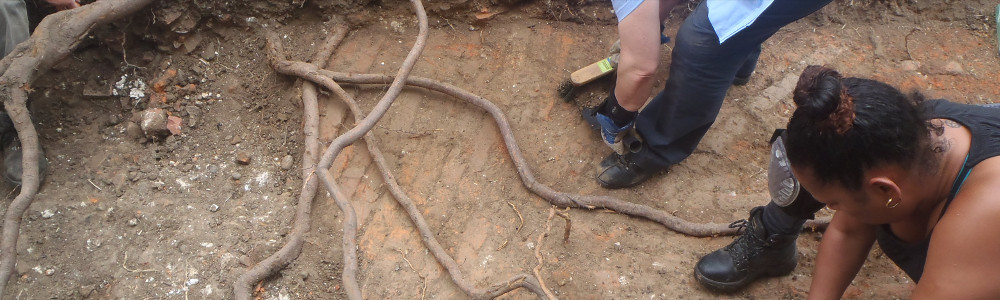

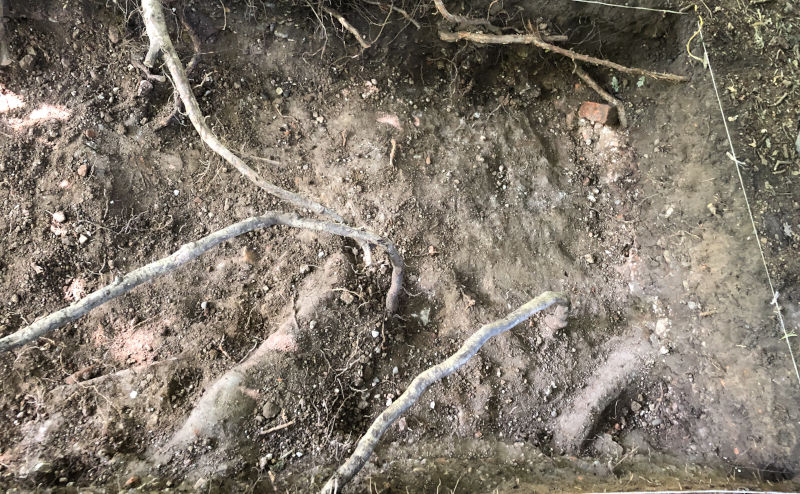

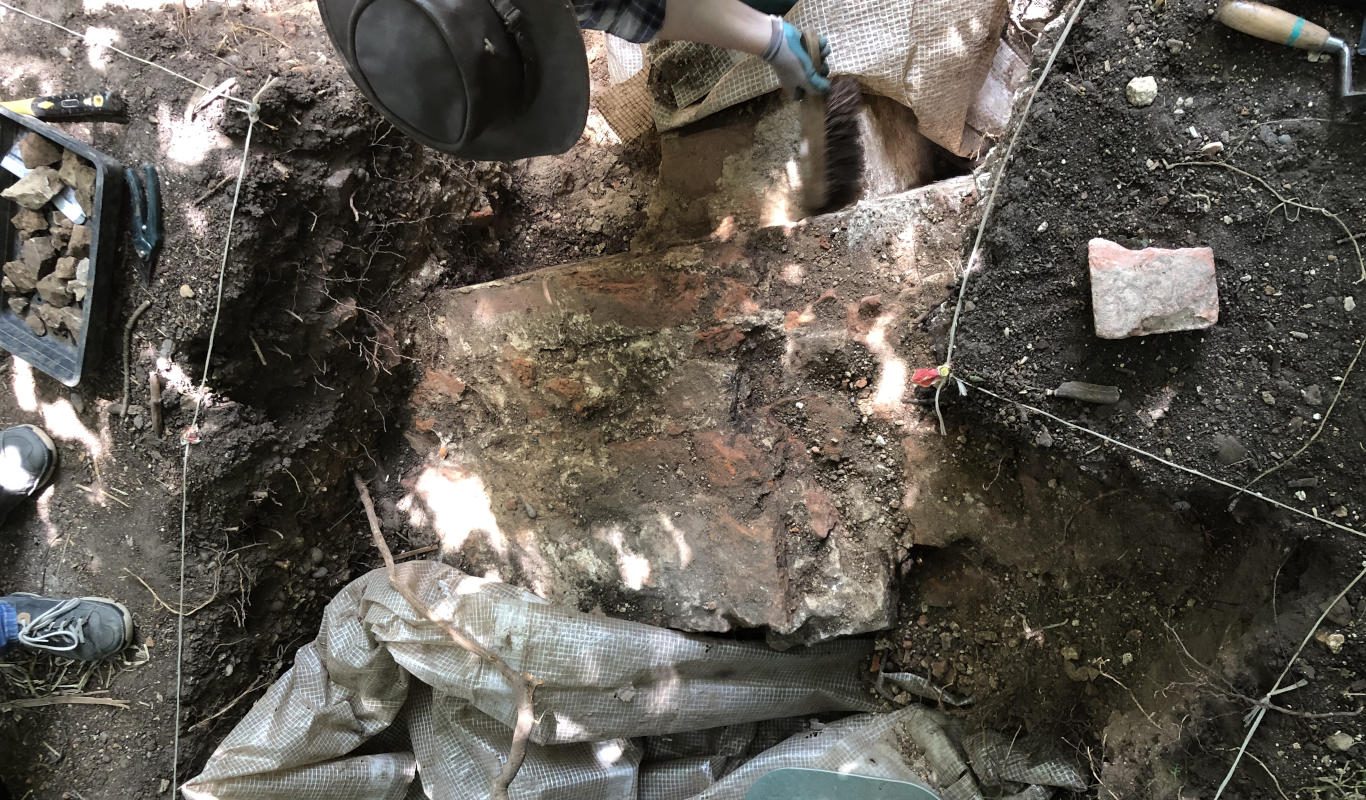

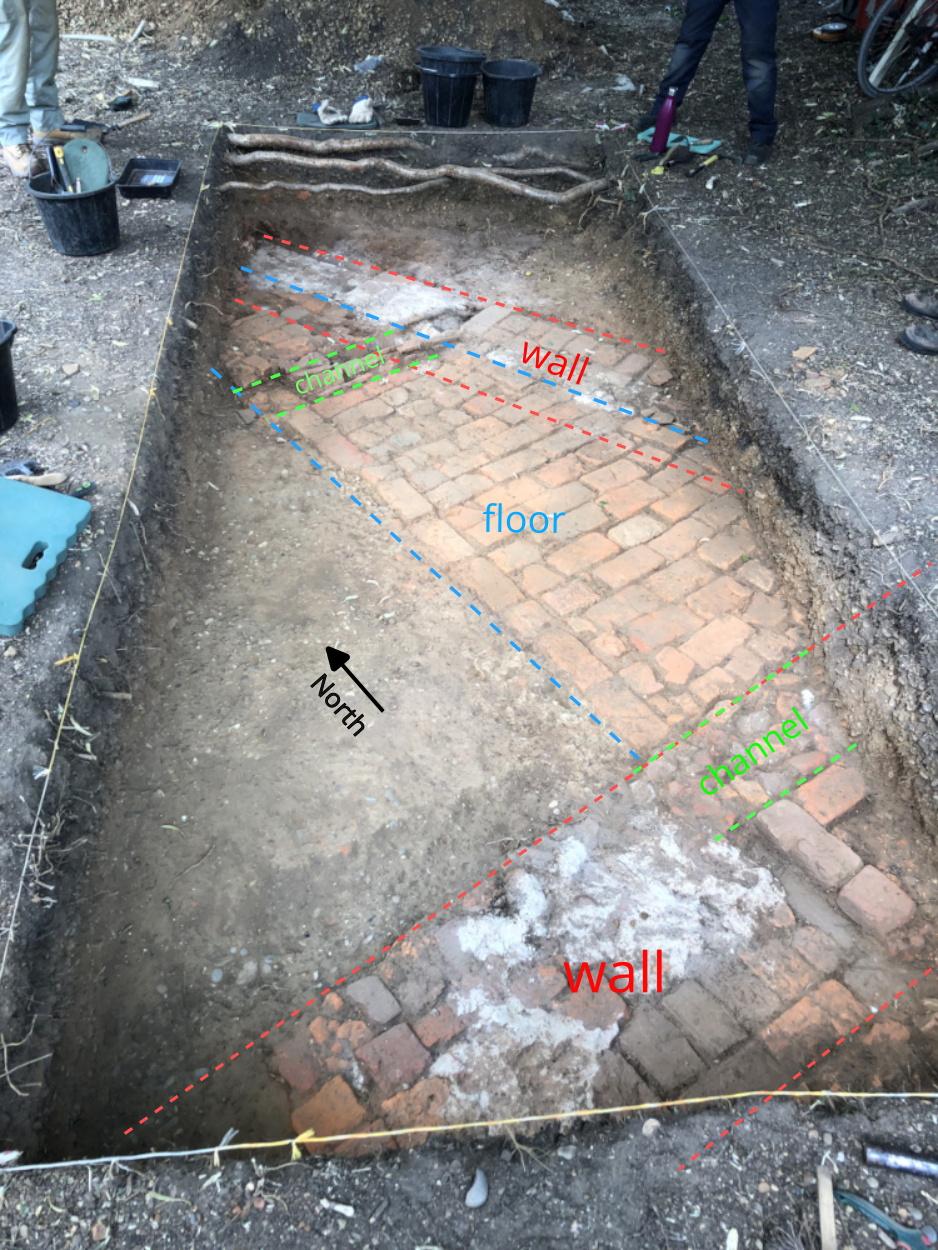

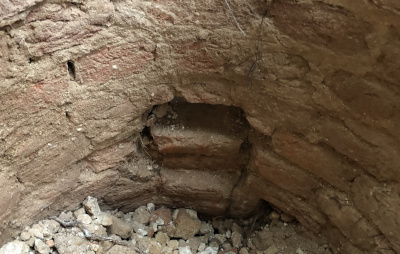

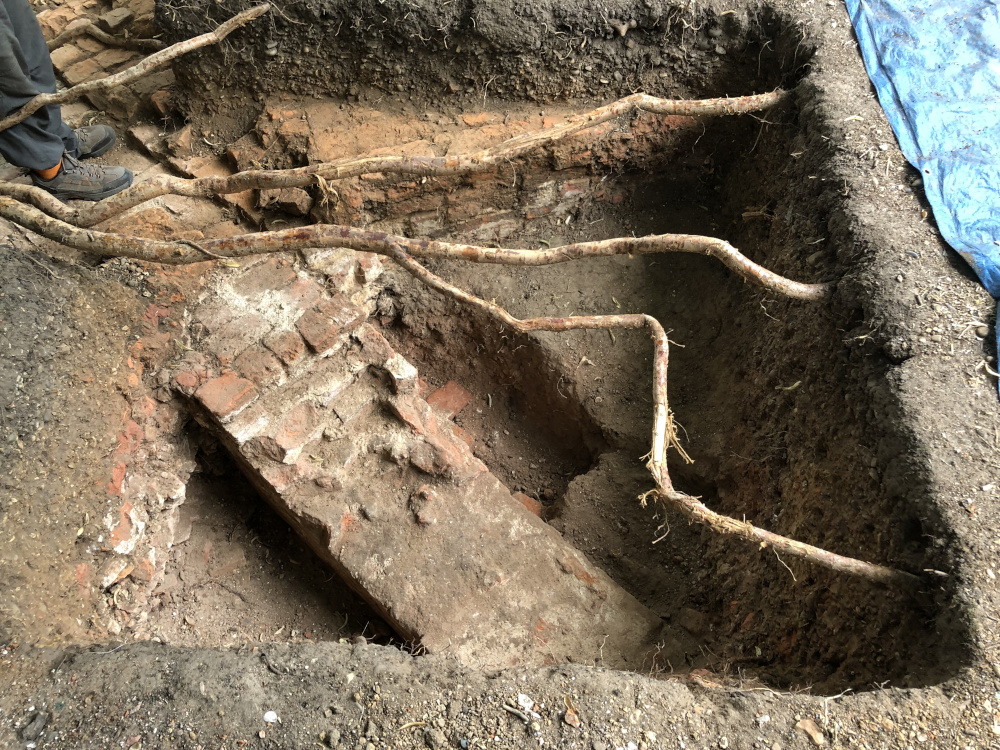

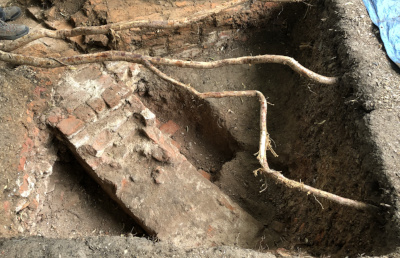

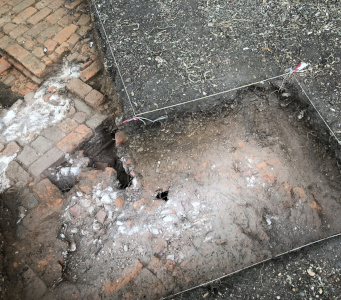

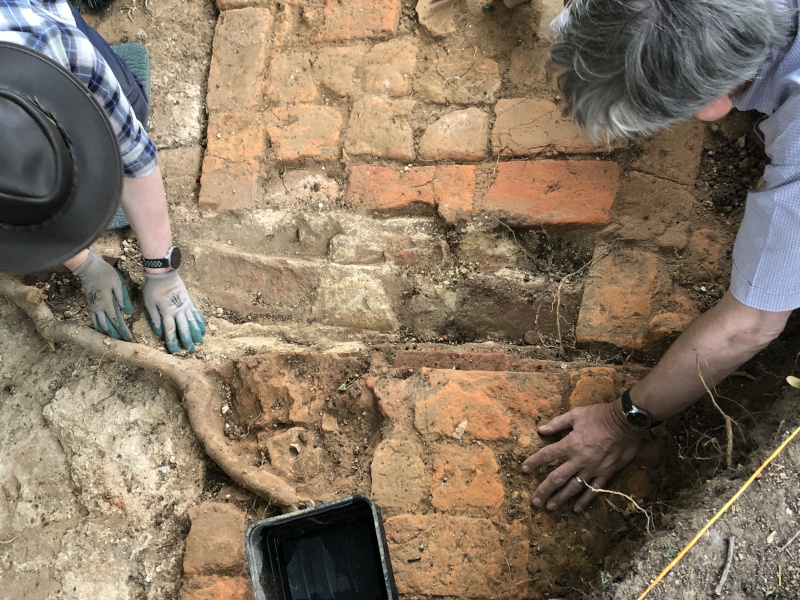

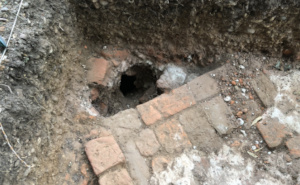

As we revealed the east edge of the well structure we found what at first looked like a single narrow channel created by an adjacent wall set againt it, and as we removed more of the very loose rubble around it we found a second channel beneath the first, connected by a vertical hole at their north end.

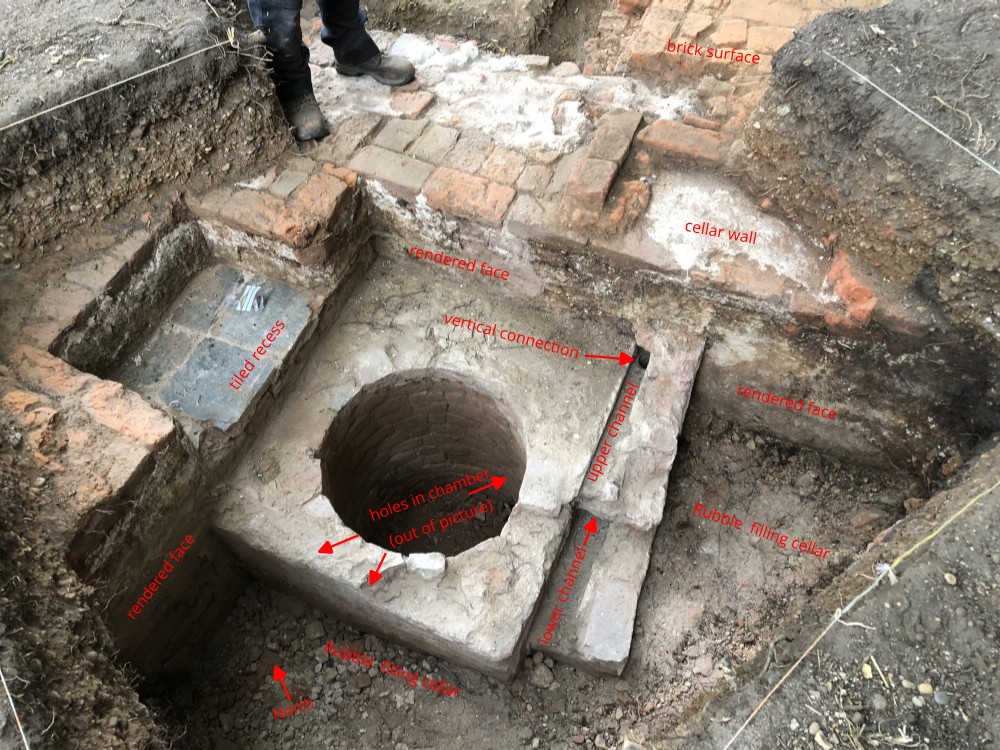

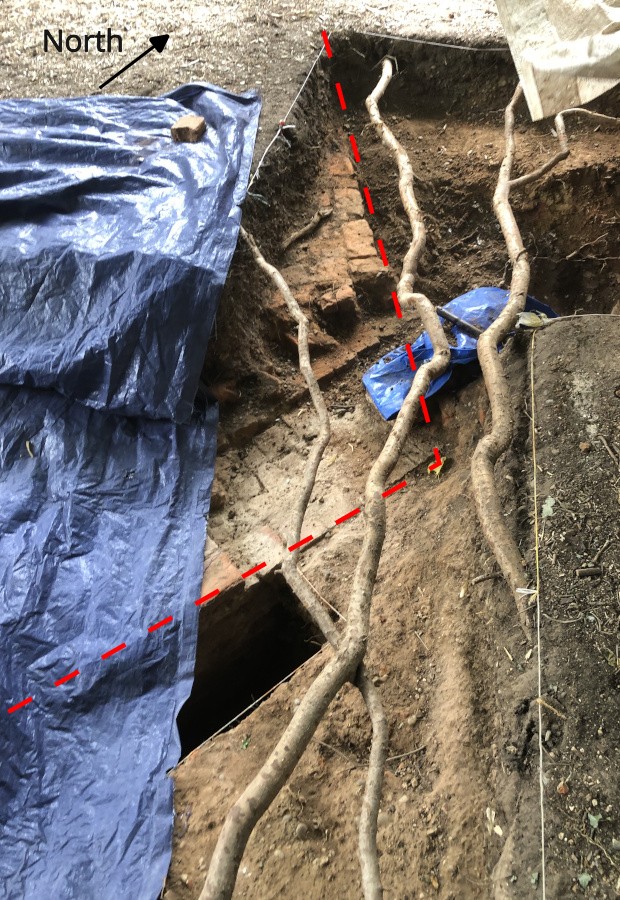

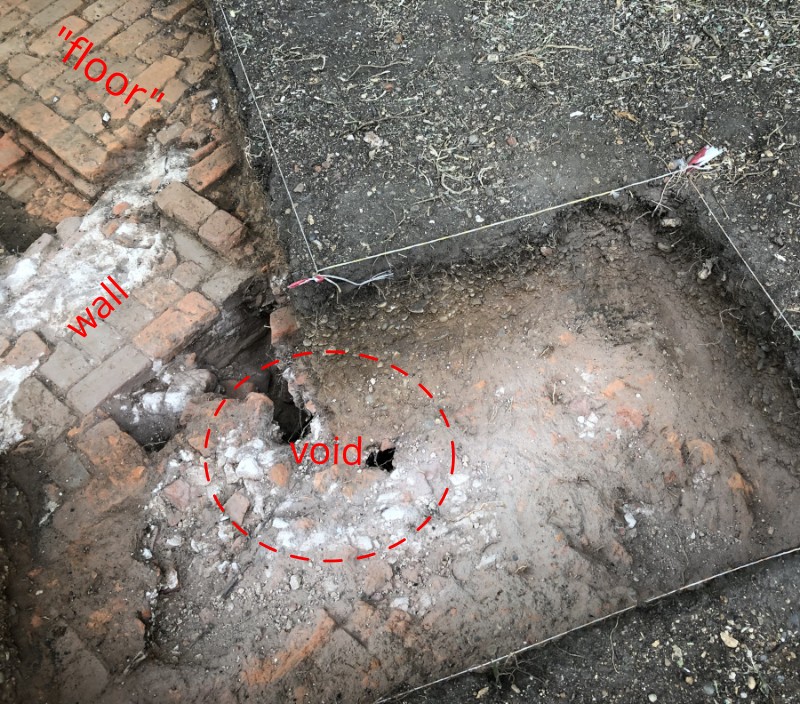

See here for an annotated version of the above

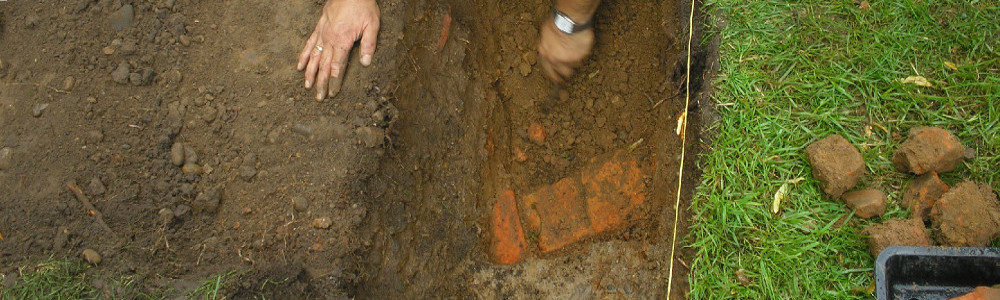

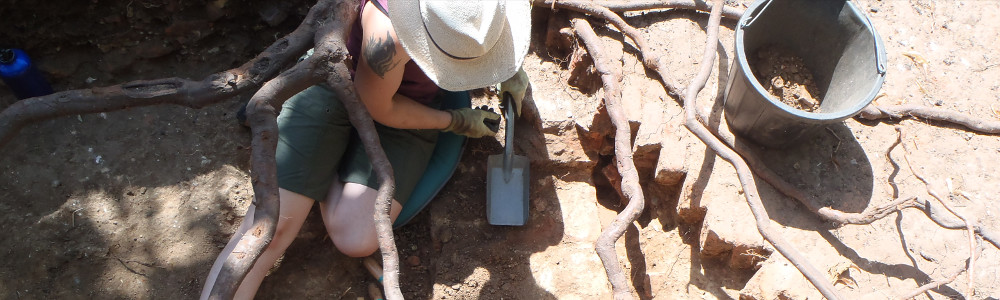

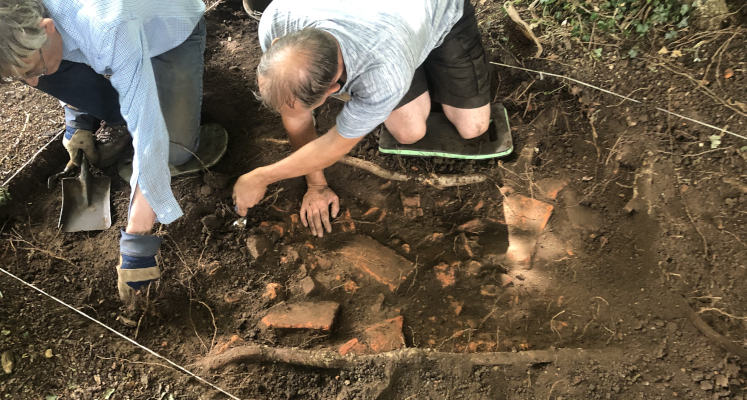

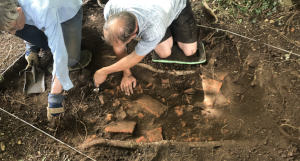

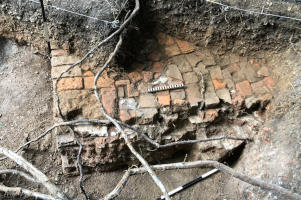

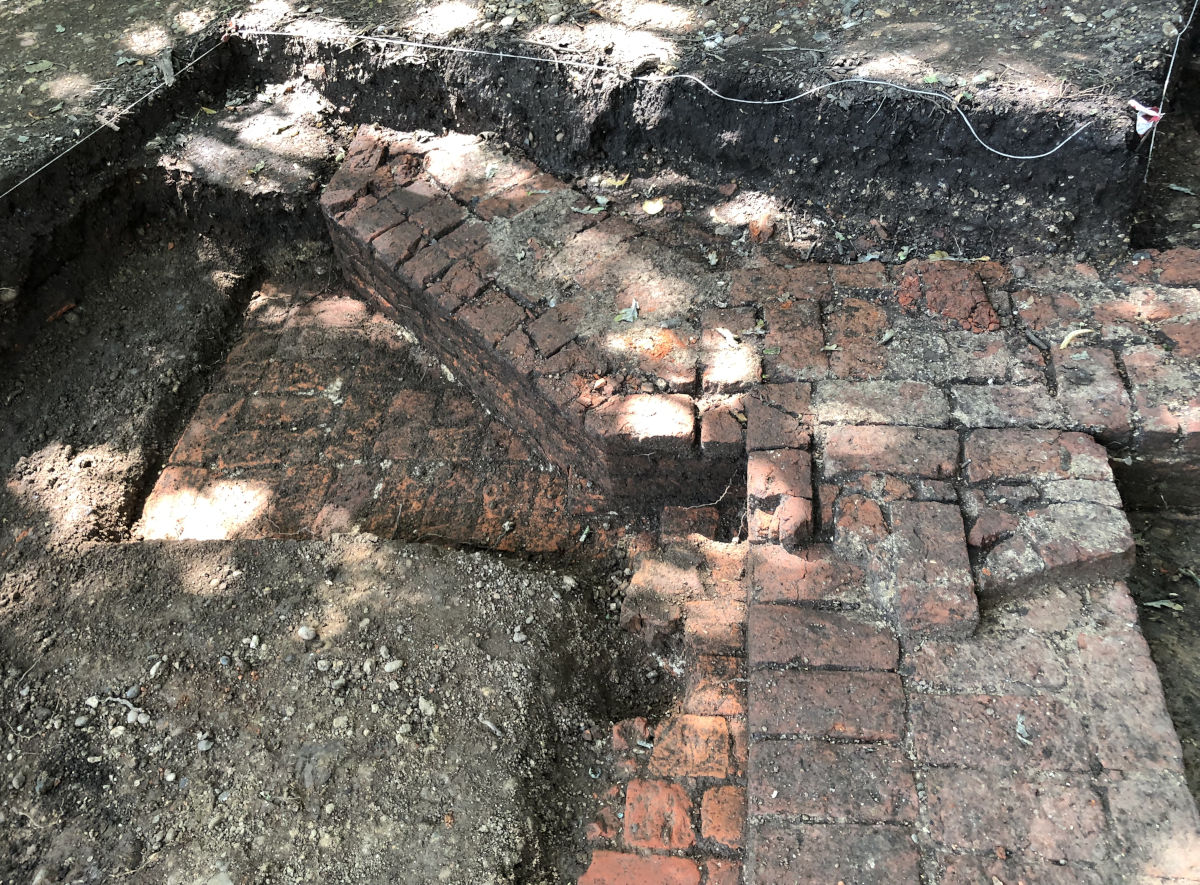

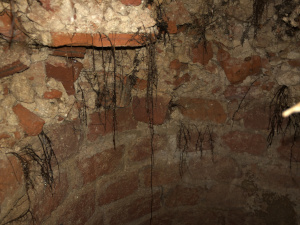

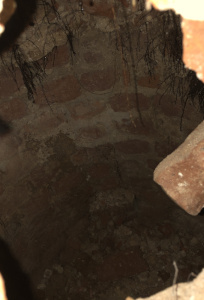

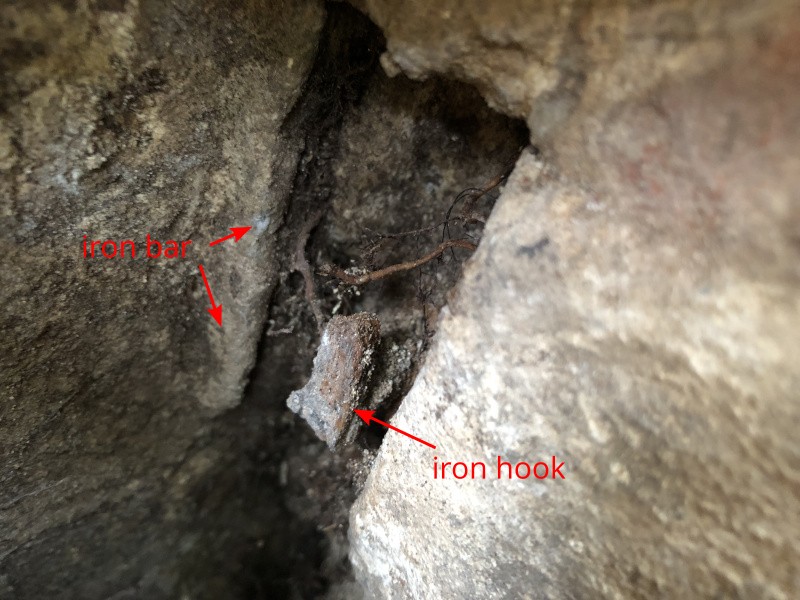

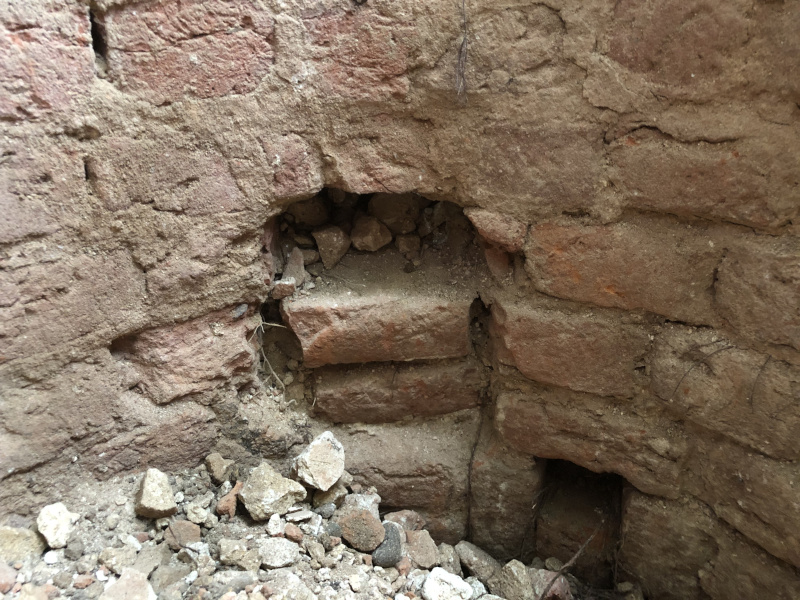

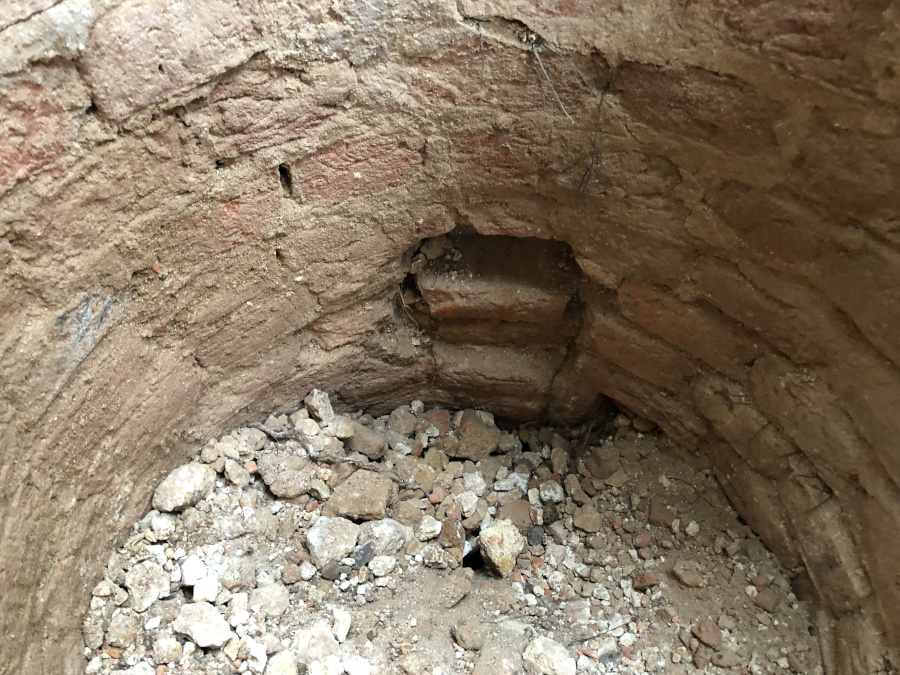

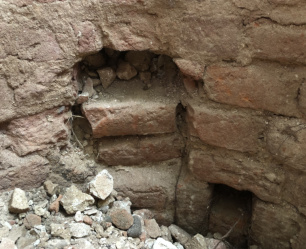

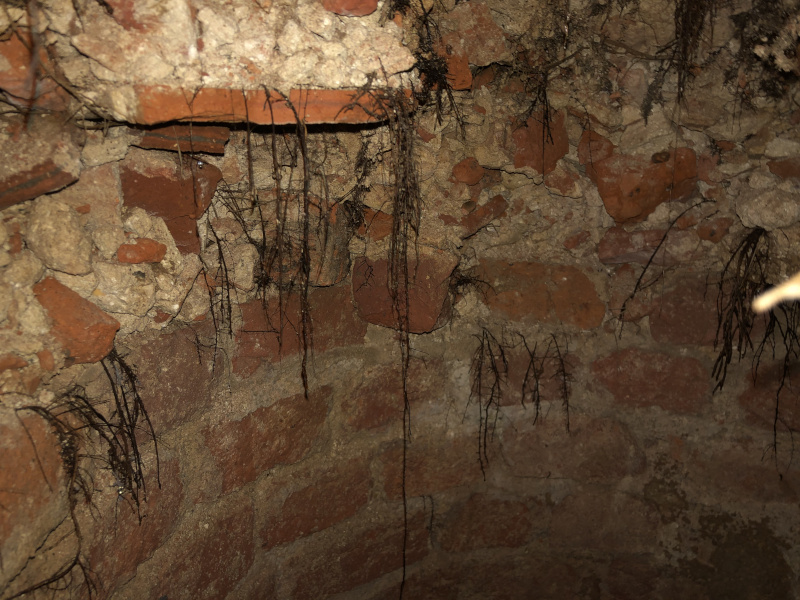

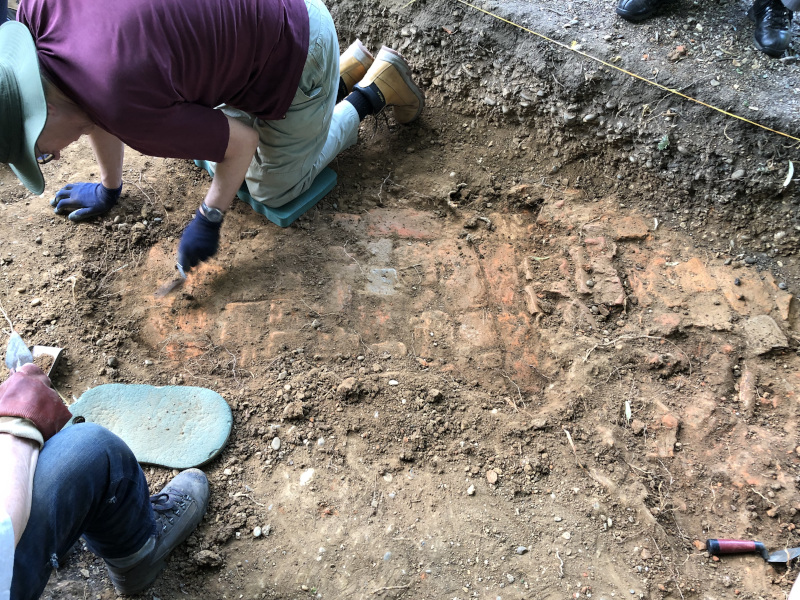

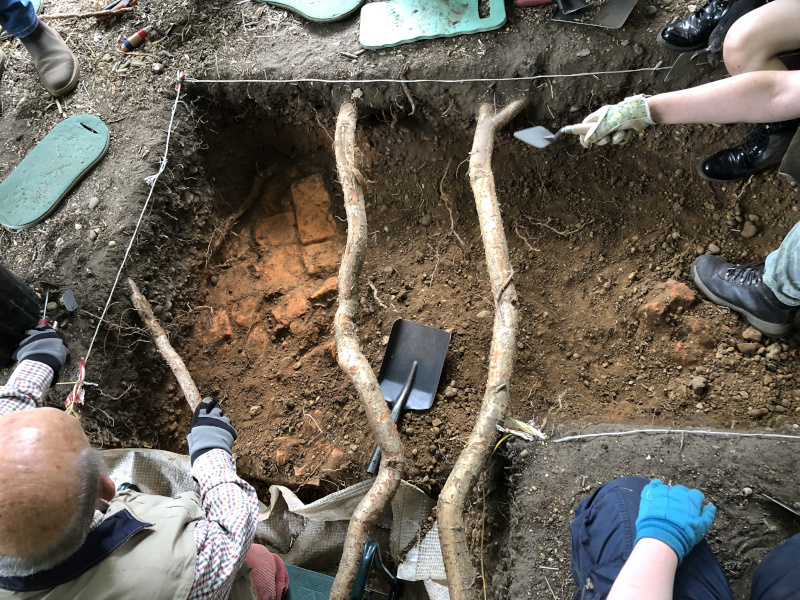

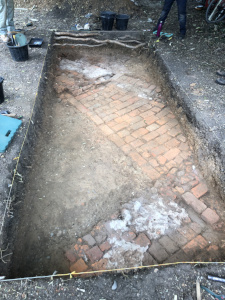

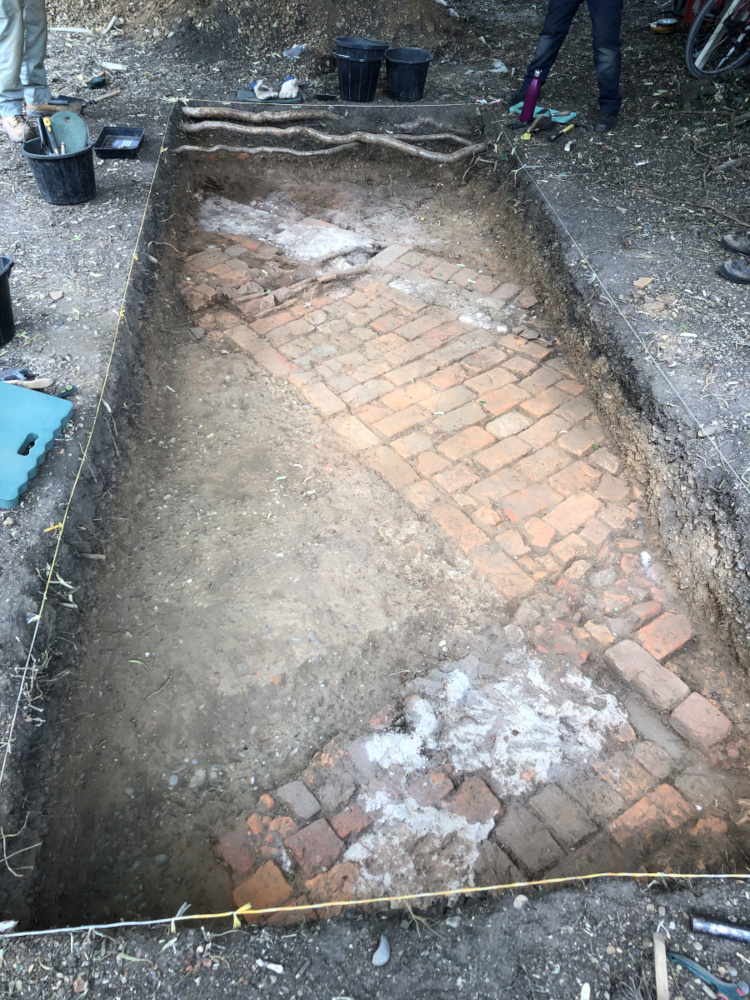

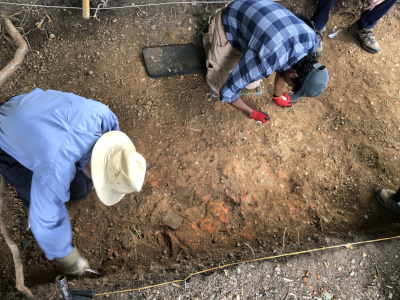

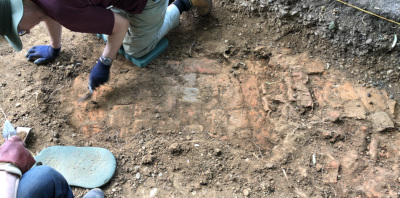

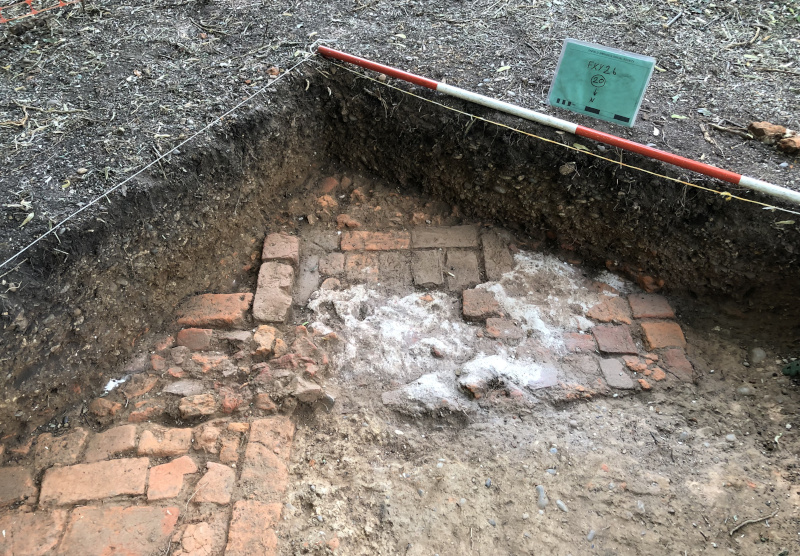

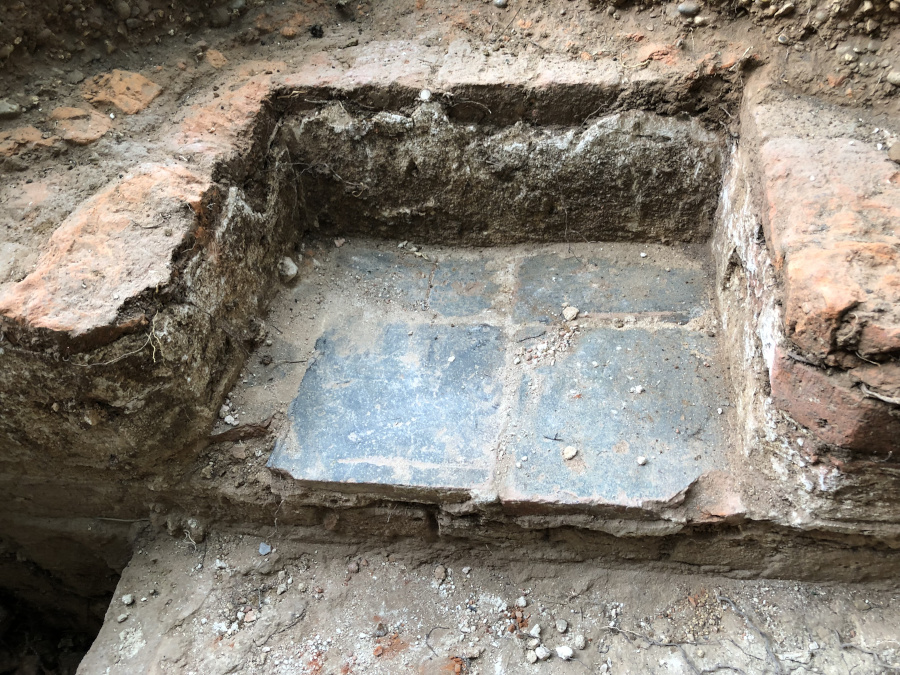

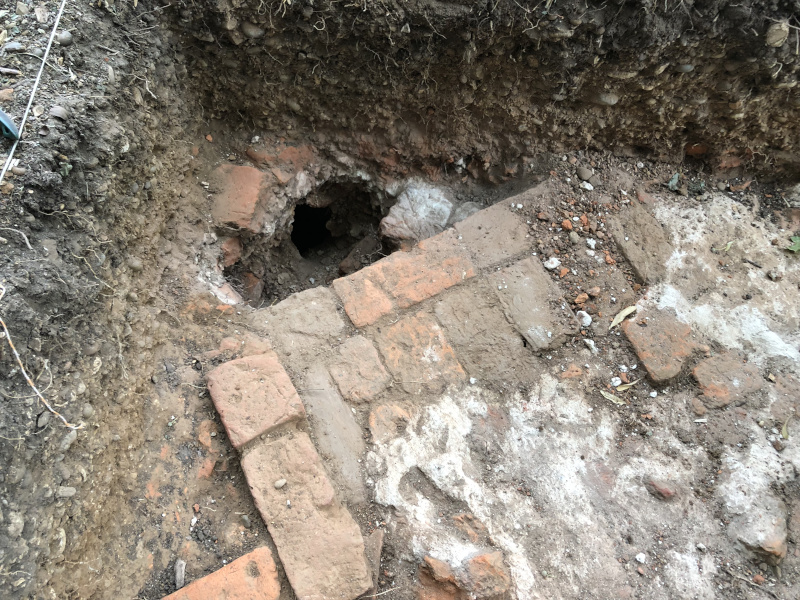

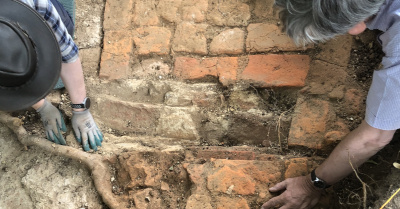

We think these two channels probably feed into the culvert that we think is beneath the nearby brick 'floor' surface. At the same time we also removed a little more rubble from inside the circular chamber, and found two more small square apertures through the brickwork - one to the side of the hole we found yesterday, and a counterpart directly opposite.

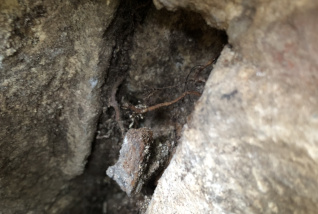

These suggest water supplies entering and/or leaving the chamber, which may point to the well in fact being a cistern or settling tank.

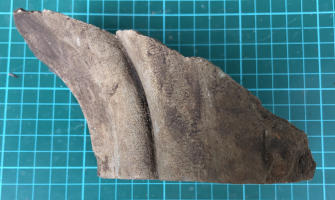

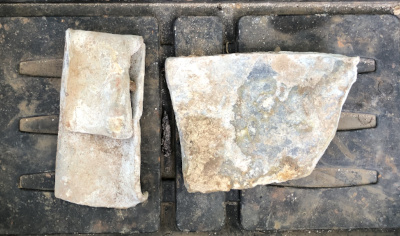

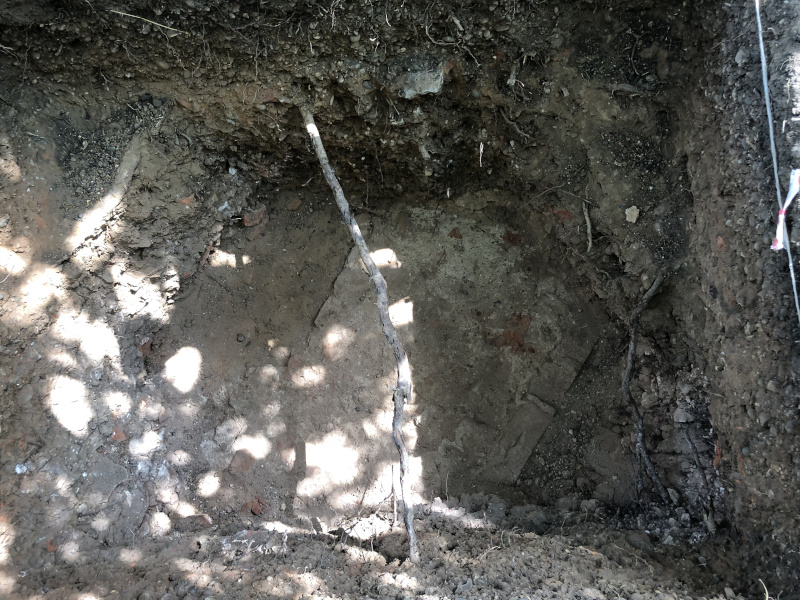

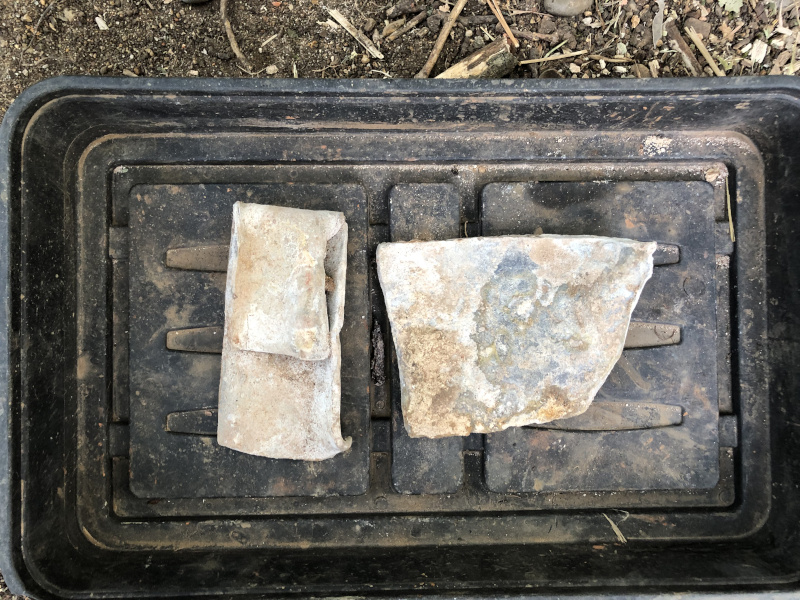

Outside the chamber, in the deep rubble fill of the adjacent cellar, we found two sizeable offcuts of lead sheet - archetypal material for water tanks.

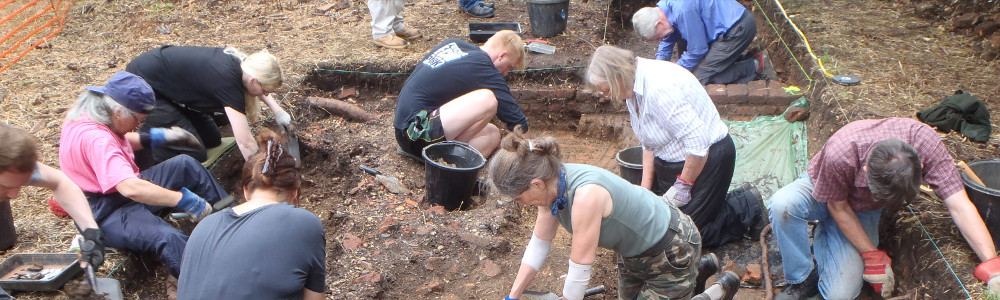

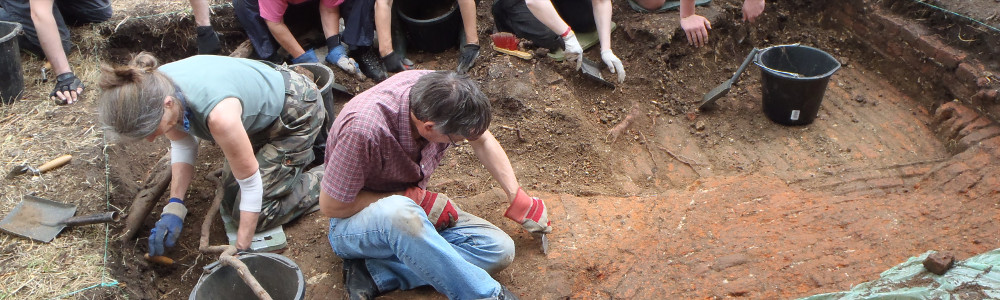

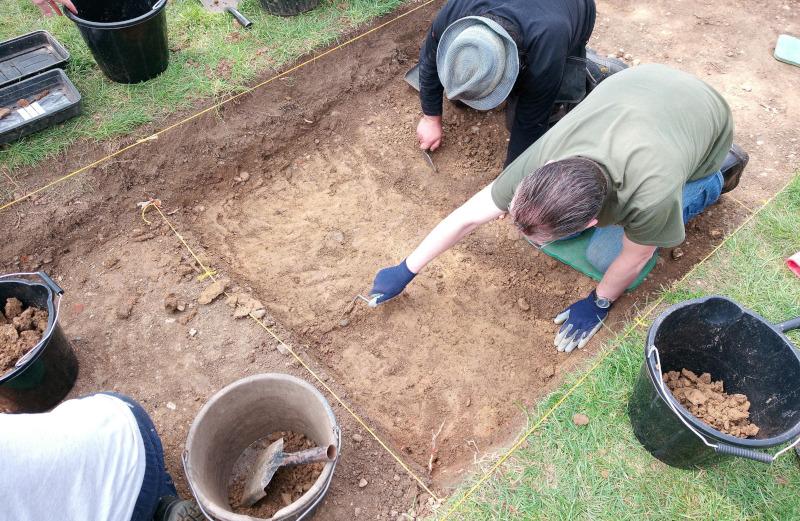

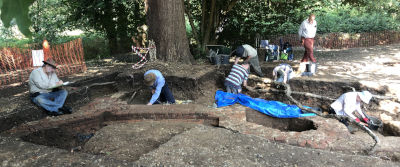

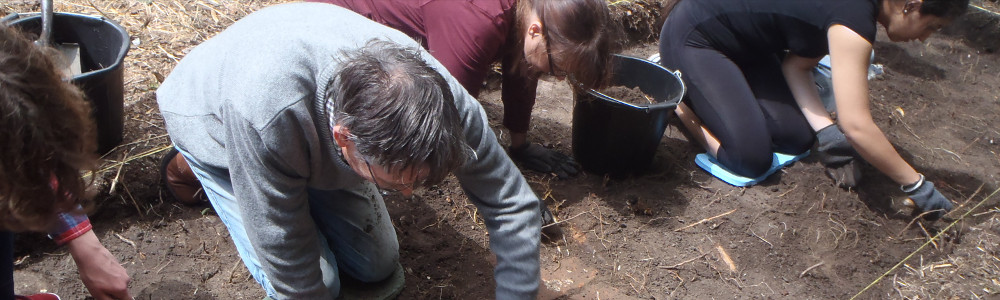

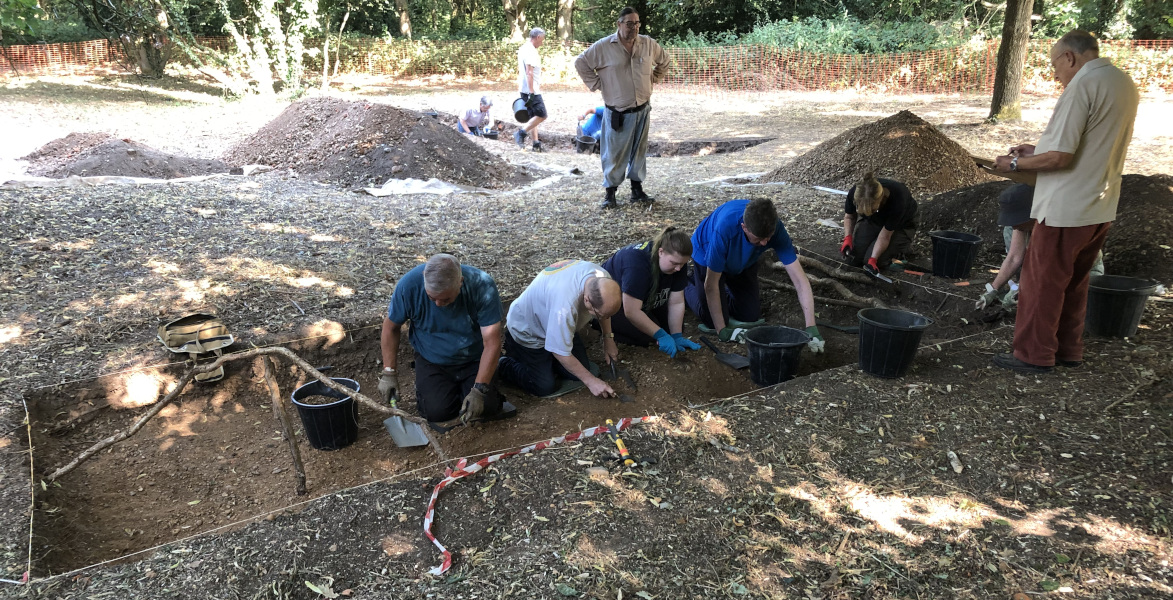

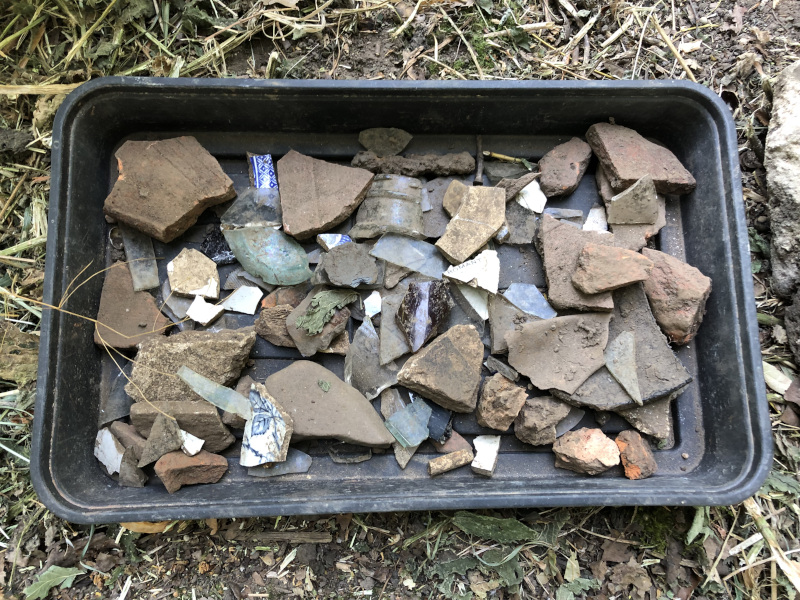

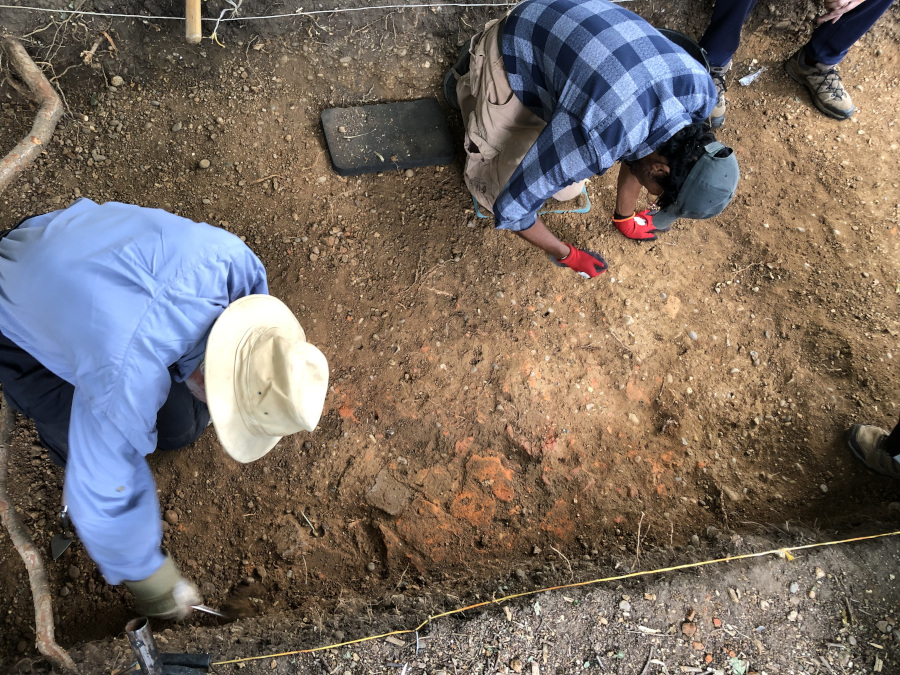

Having done about as much digging here as is practical, the main remaining job at the south end of the trench for tomorrow is to clean up and meticulously record every detail of all of these various structures in order to better understand them.

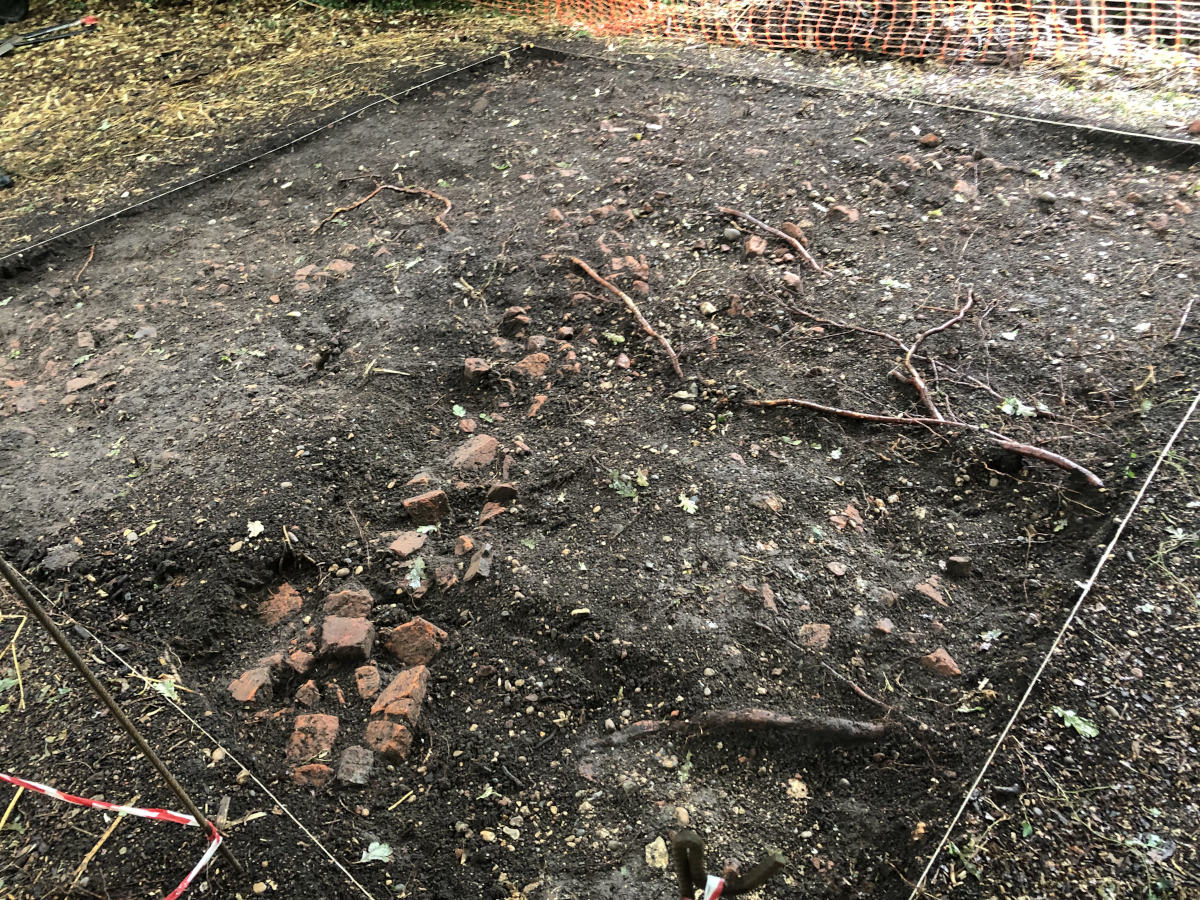

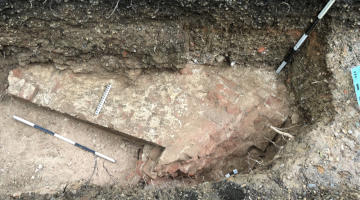

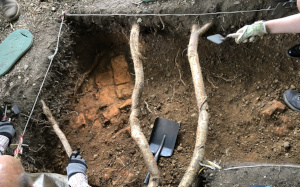

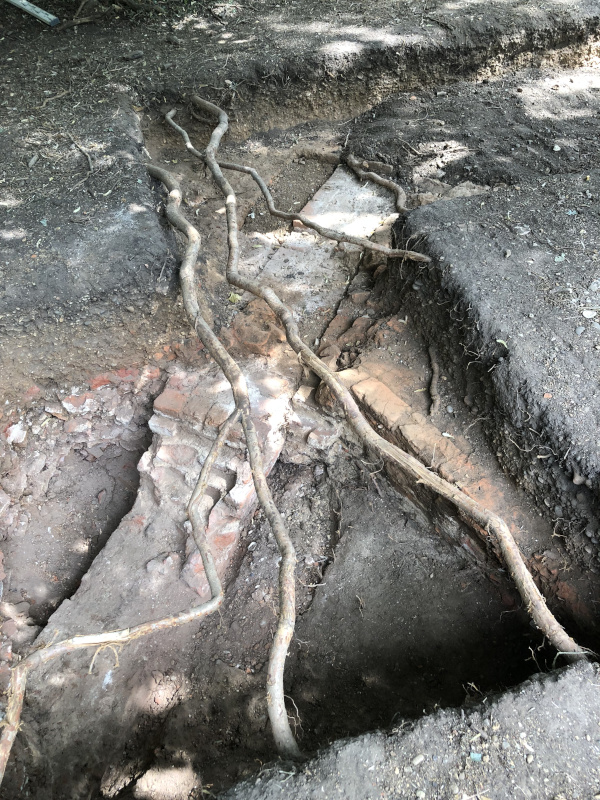

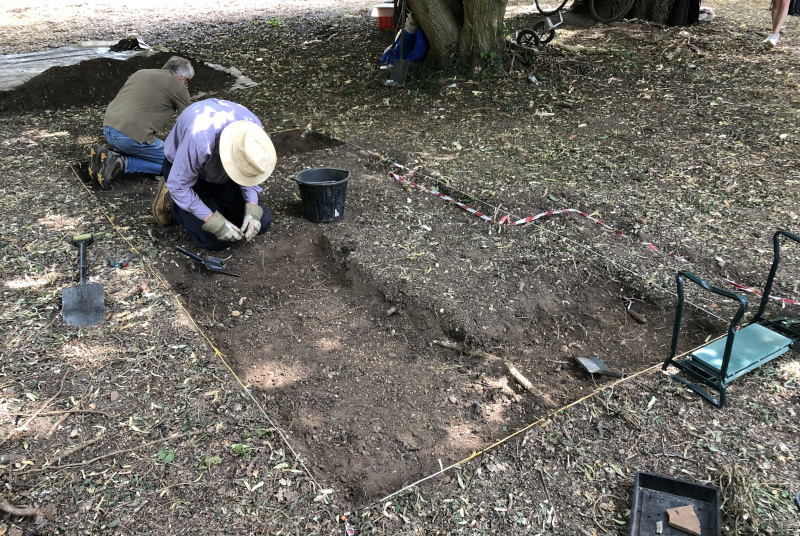

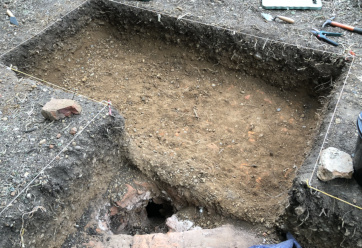

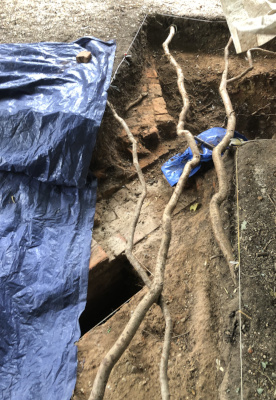

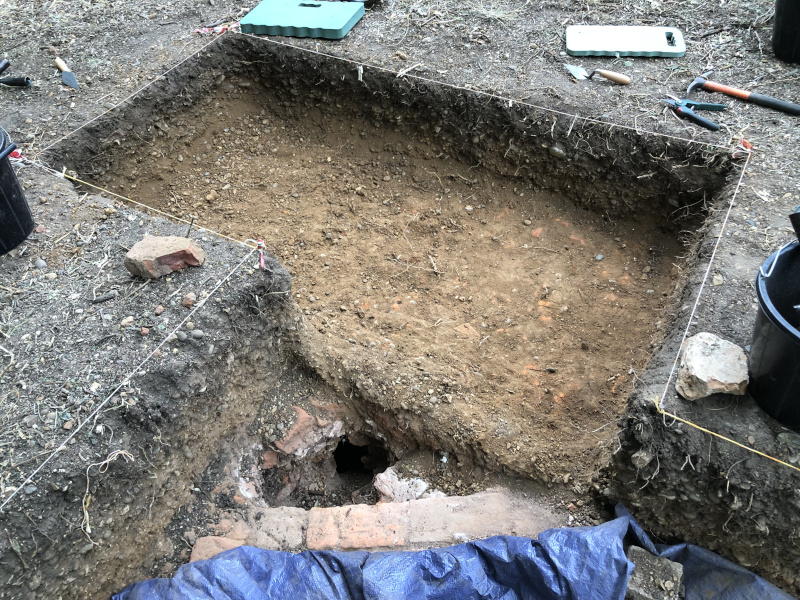

Meanwhile at the opposite end of the trench, the extension that we opened to follow the wall/culvert partially succeeded, in as much as it has found more of the wall, but in typical Elsyng fasion the wall has arbitrarily changed course and vanishes off into the trench corner.
We will finish up excavating the extension but it looks like finding the ultimate destination of the wall/culvert will be a job for another year.
The focus from tomorrow will be to finish off digging jobs as quickly as possible and get everything recorded hopefully before Sunday.

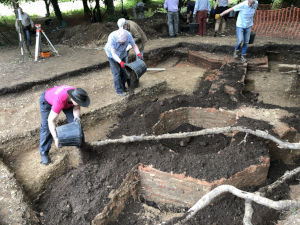

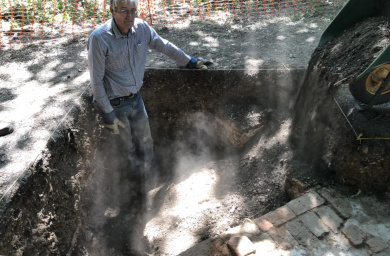

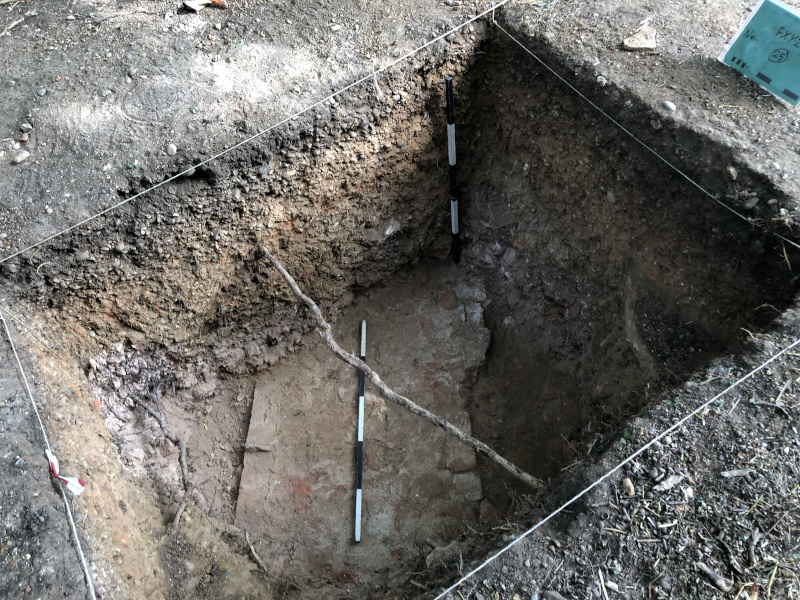

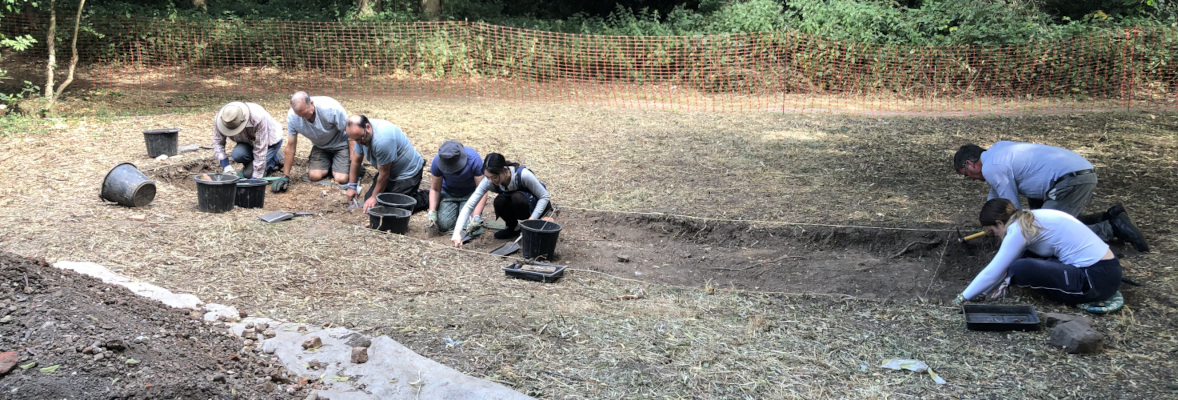

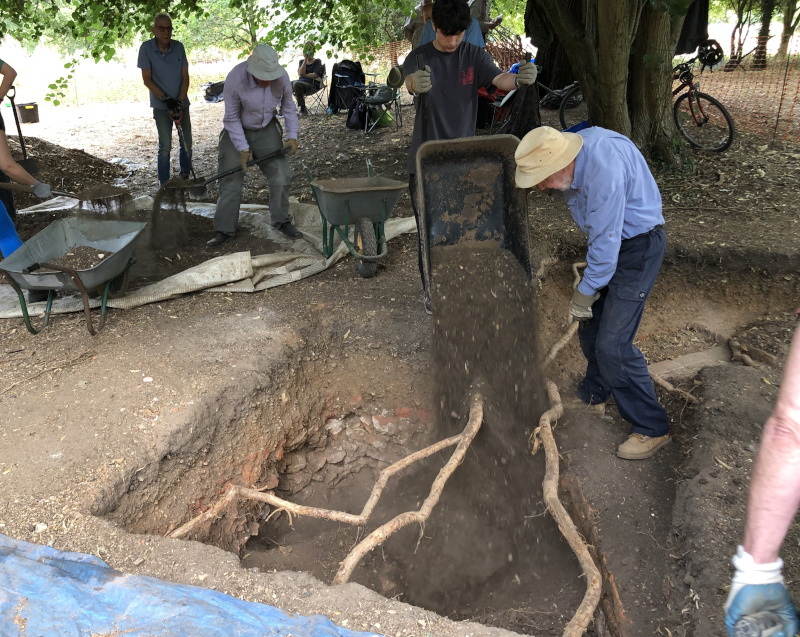

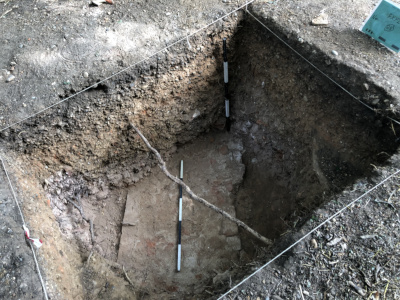

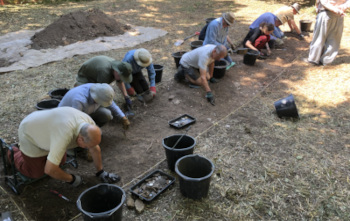

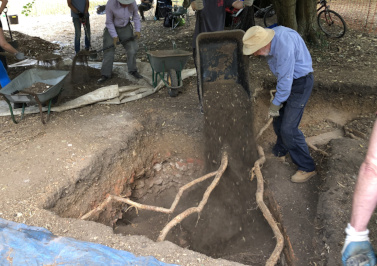

Trenches 1, 3 and 4 have mostly been backfilled and we'd like not to have to spend too much of Sunday backfilling Trench 2, especially in light of the possible rain creeping up on the forecast.
